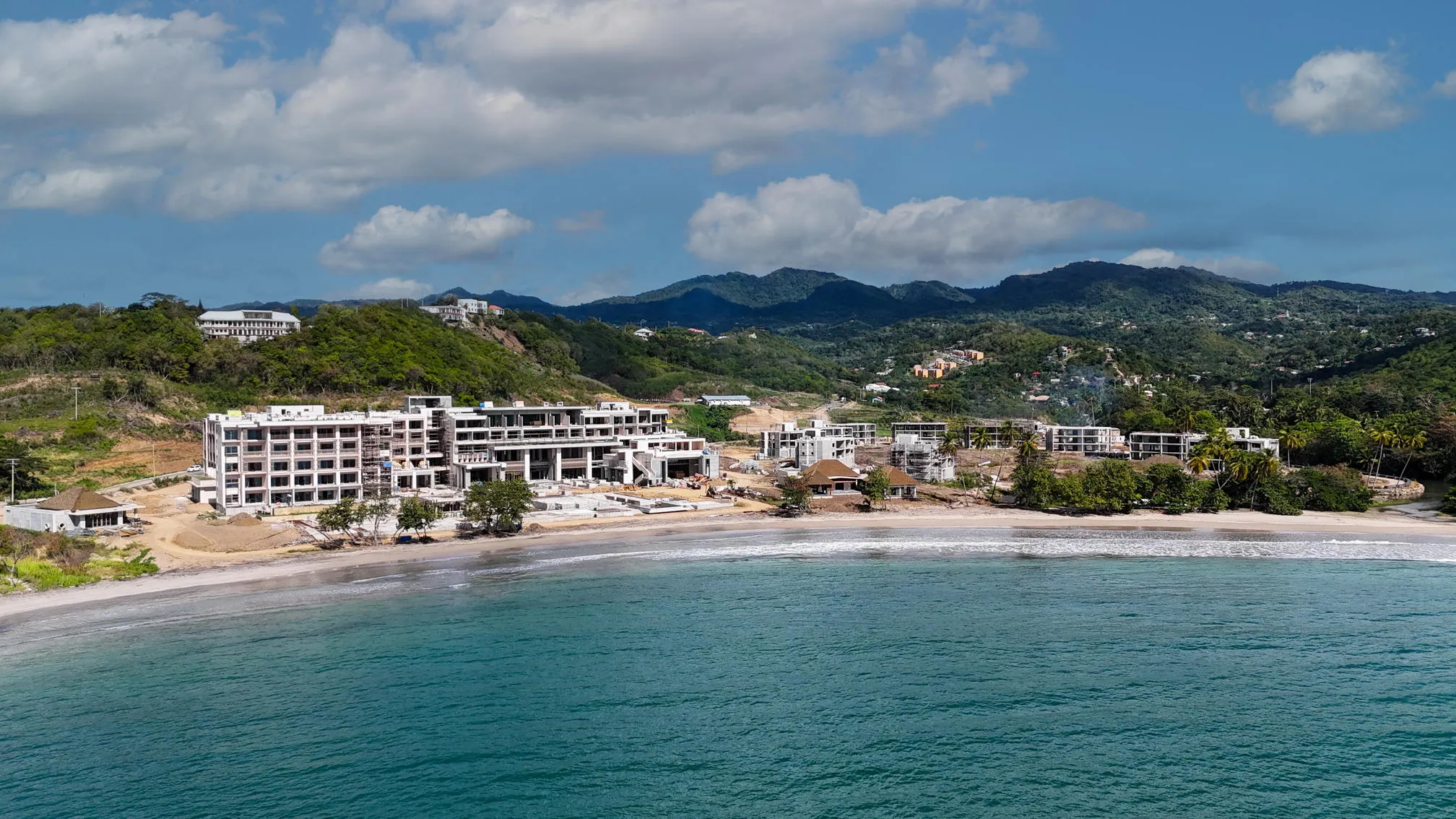

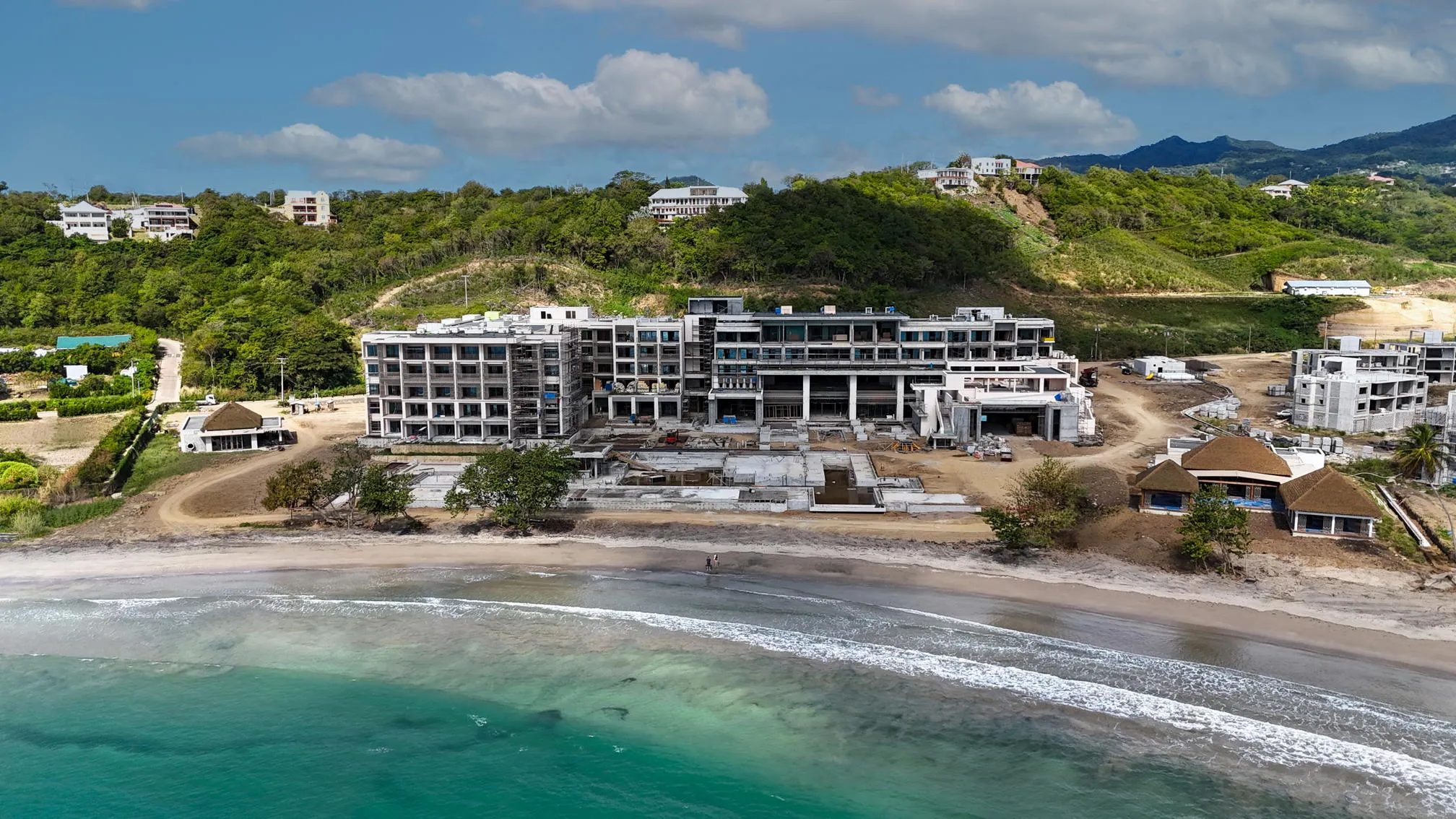

Siga la transformación de nuestros desarrollos emblemáticos con actualizaciones mensuales sobre el progreso in situ

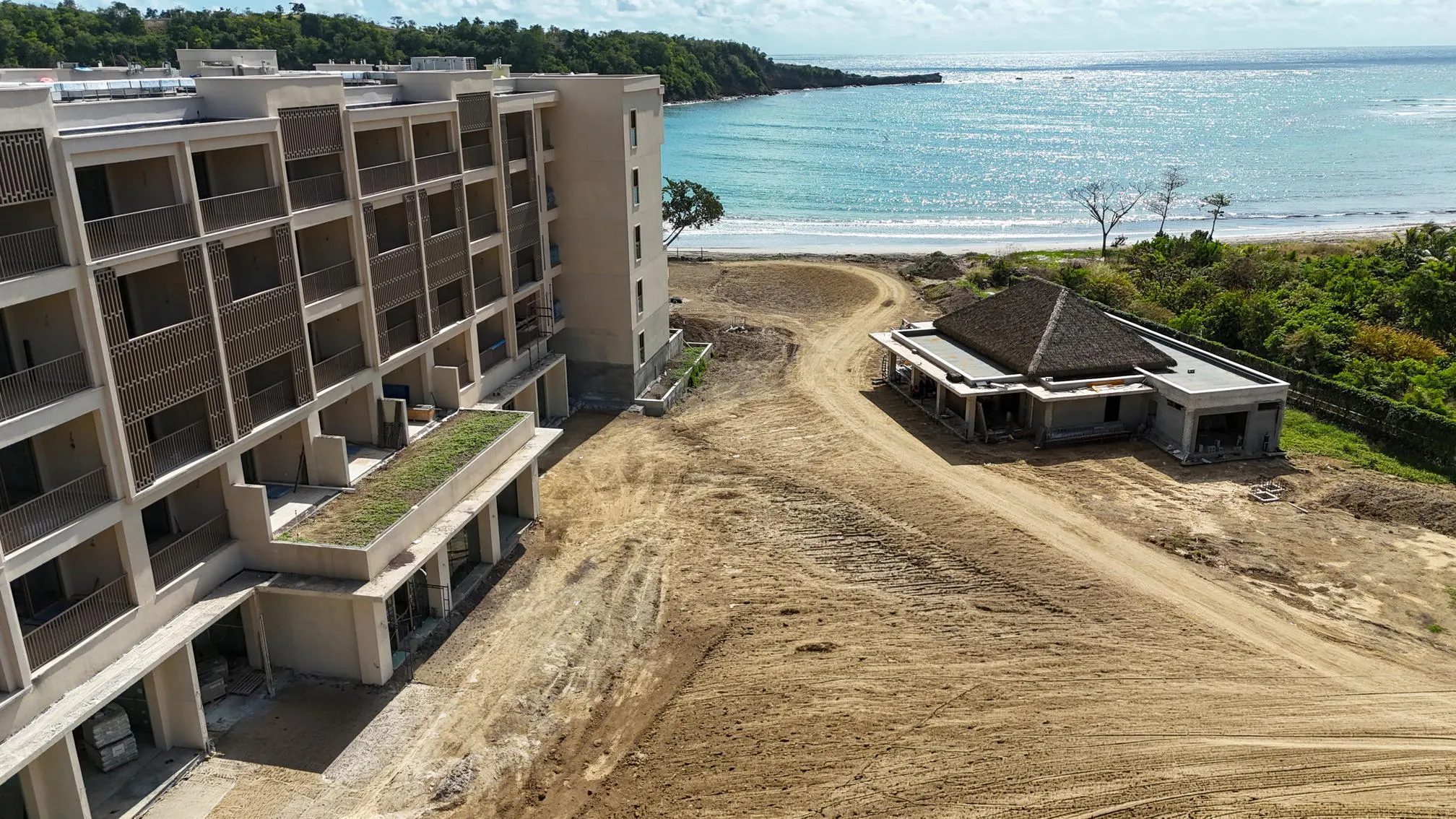

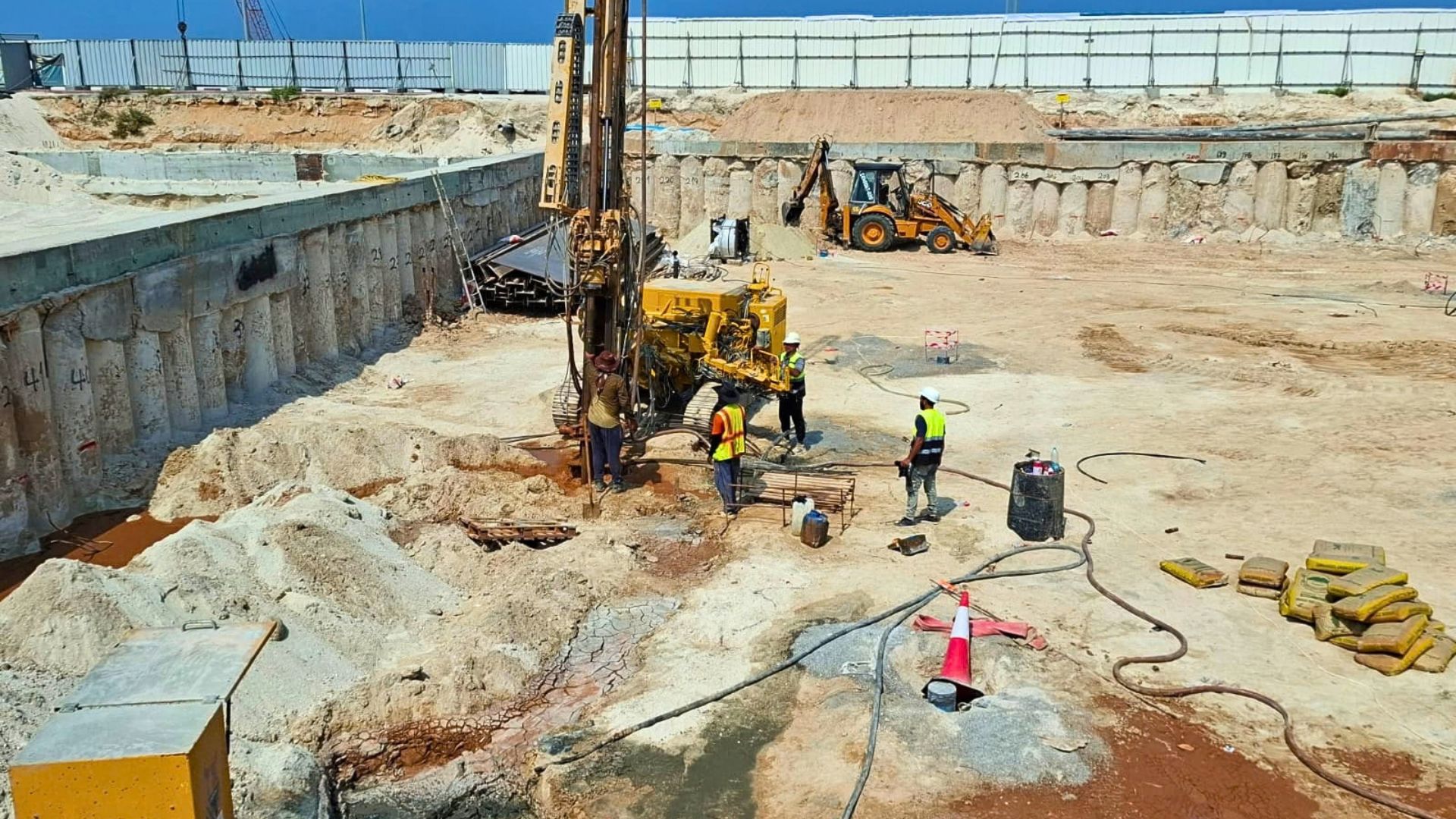

Intercontinental Grenada - La Sagesse
Desarrollo continuo
Realice un seguimiento del progreso continuo de nuestros proyectos a medida que evolucionan de la visión a la realidad, moldeados con precisión y artesanía de primer nivel.
Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

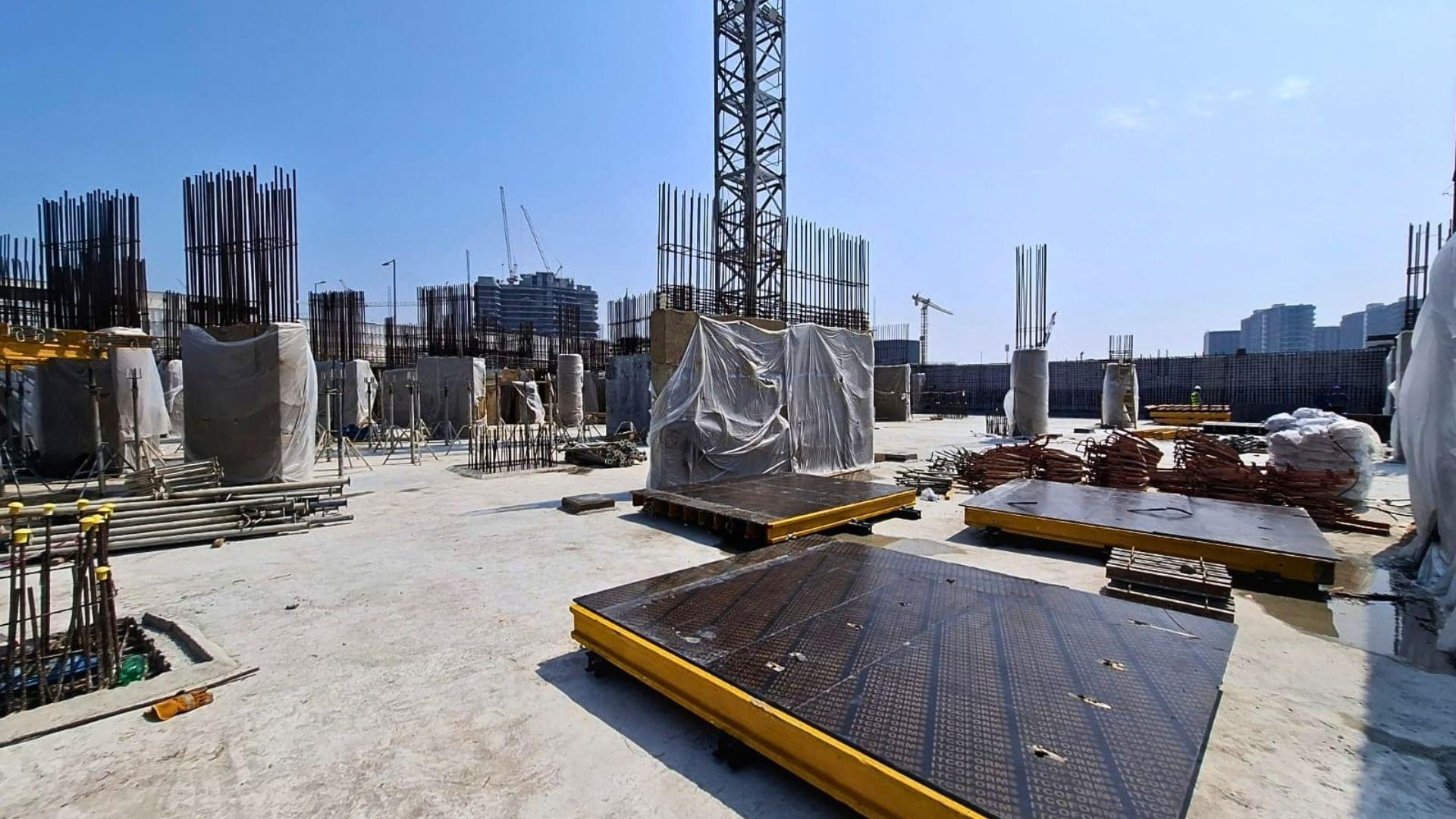

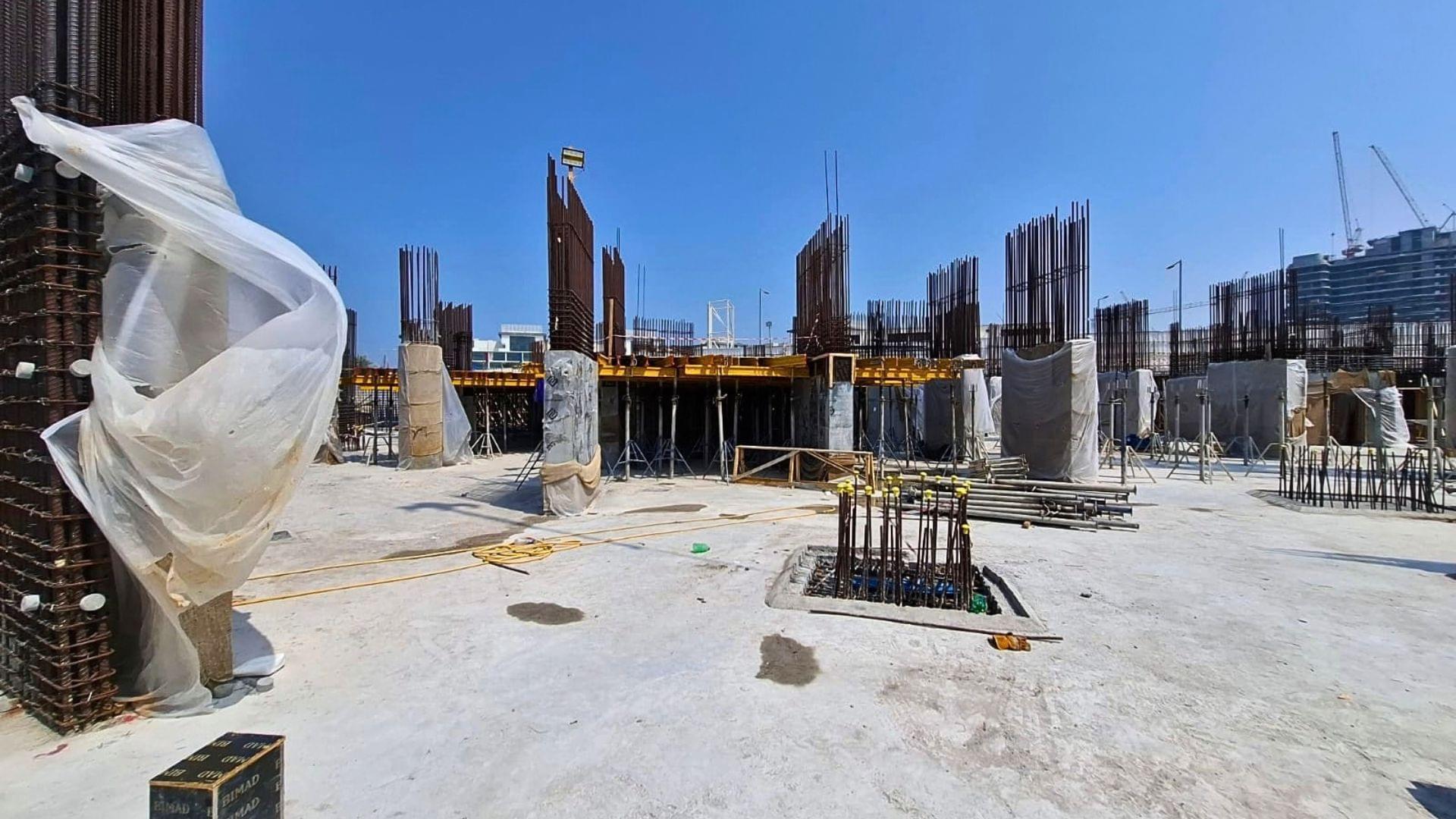

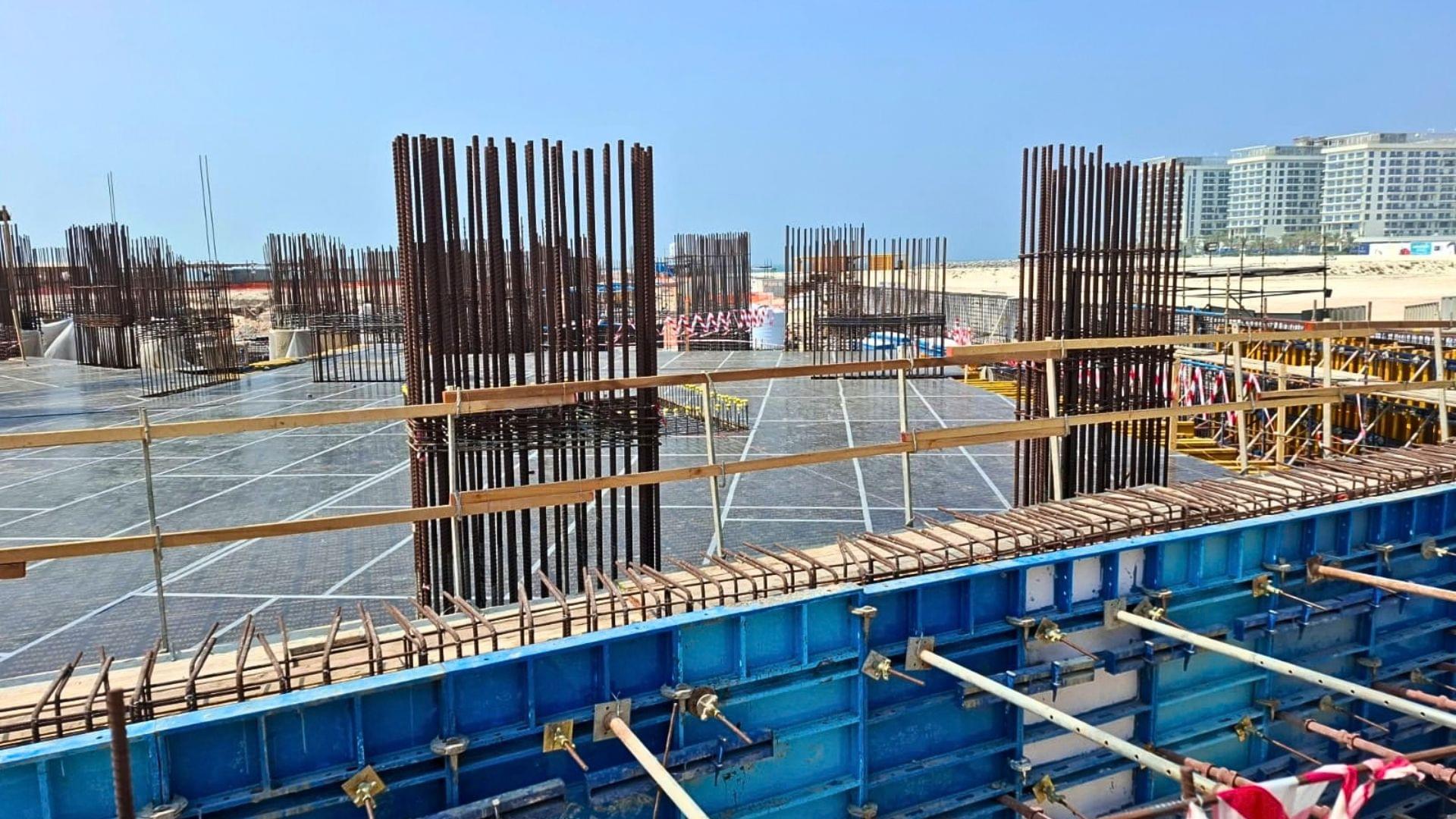

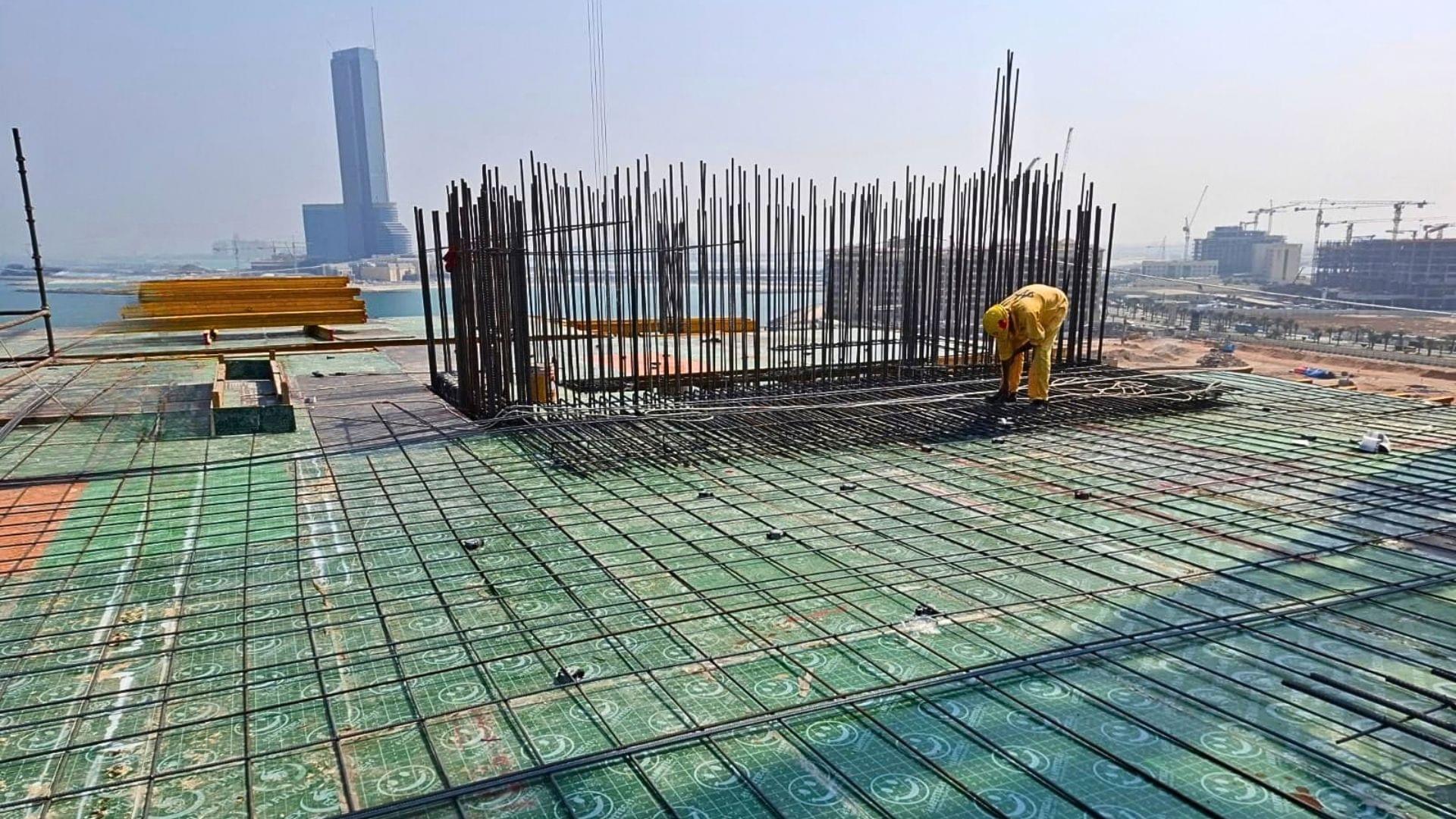

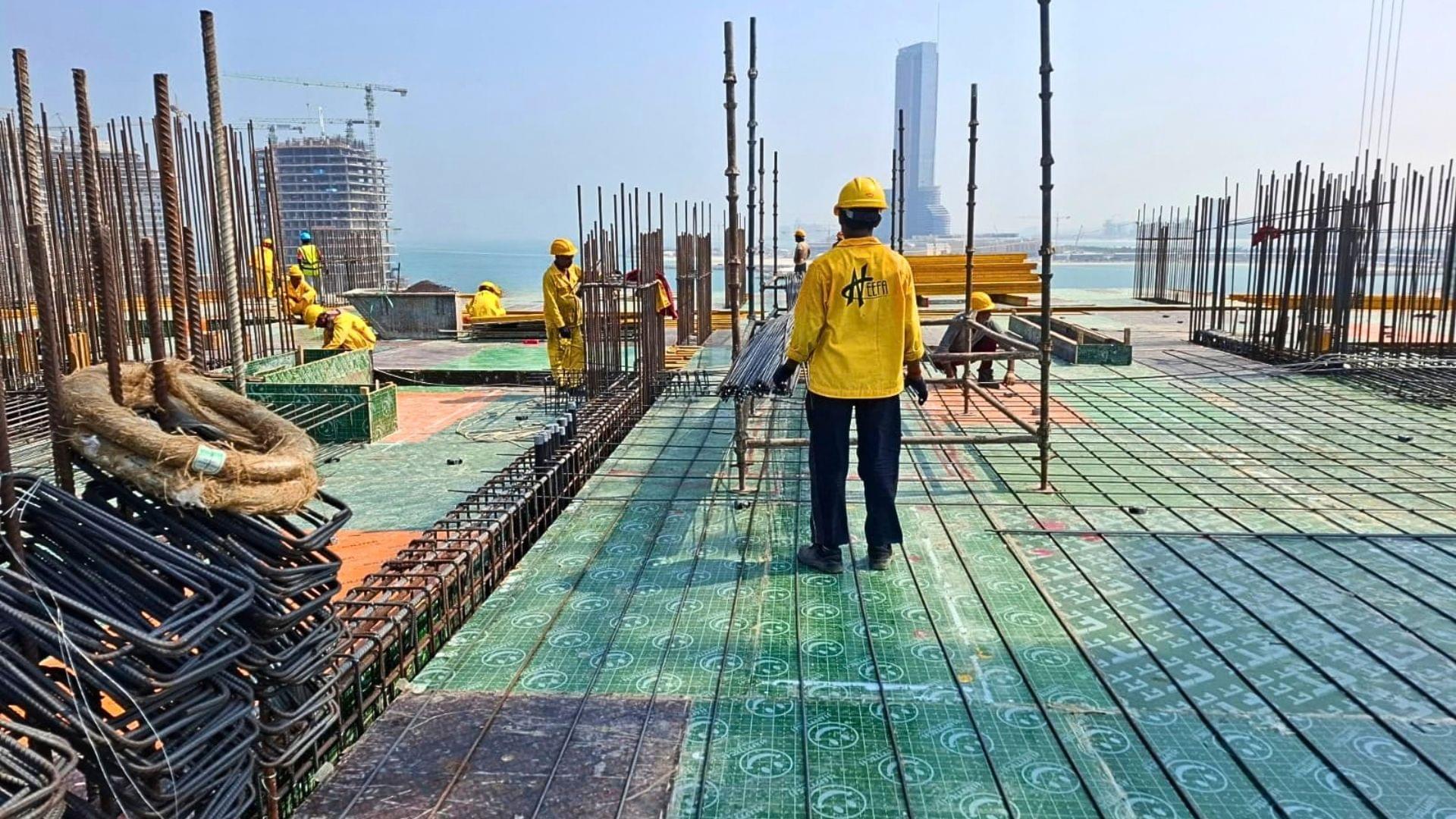

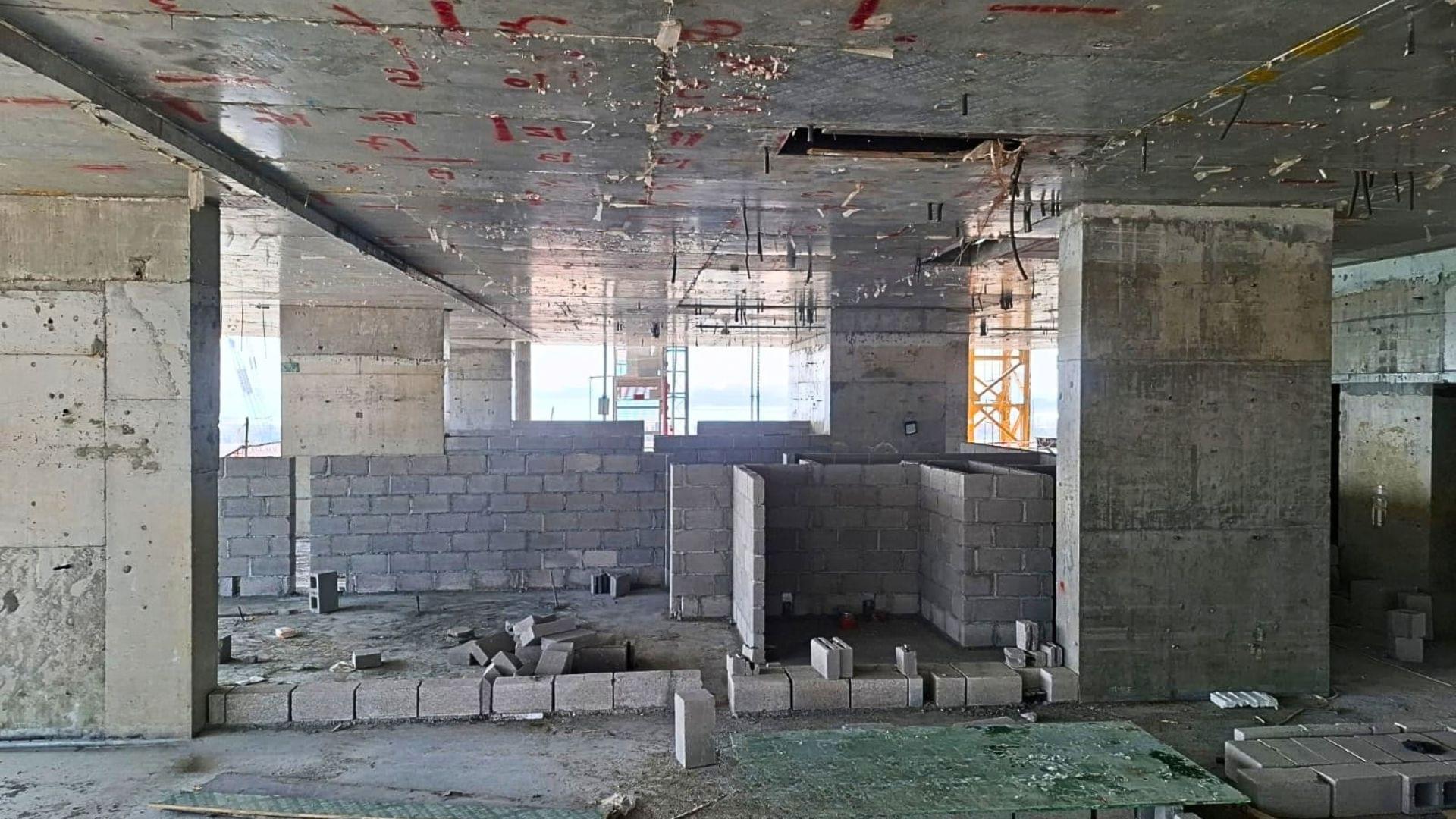

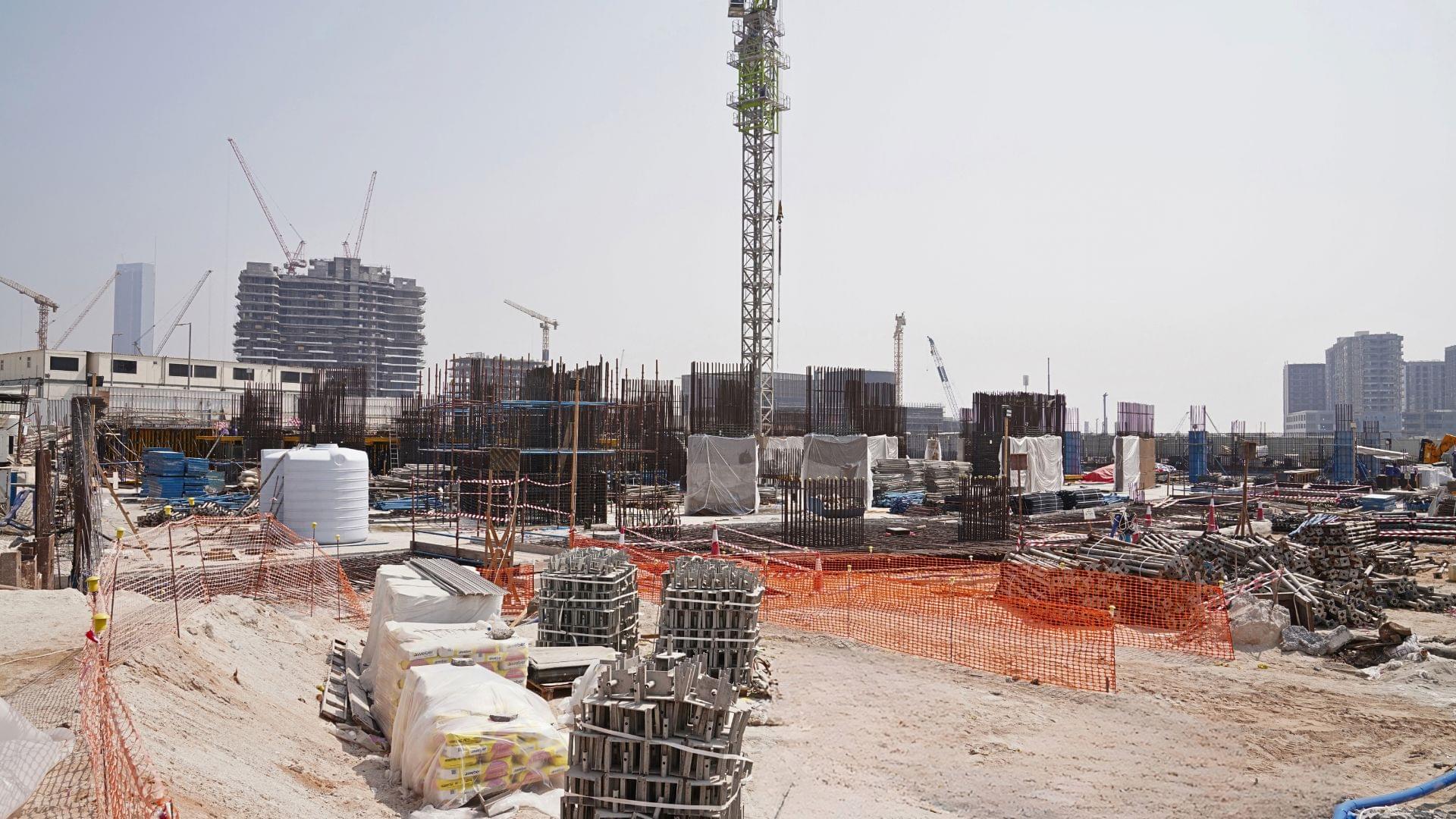

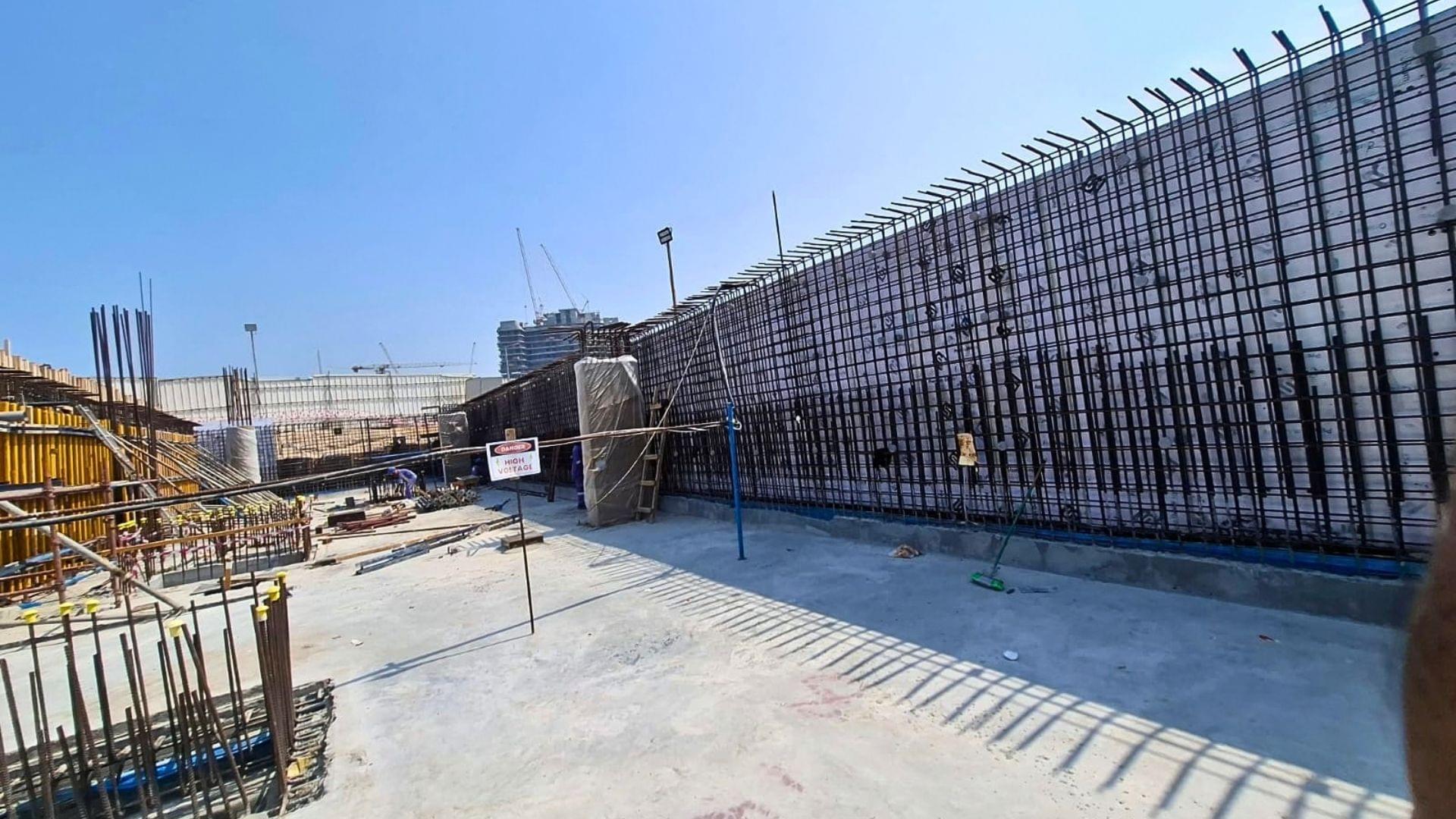

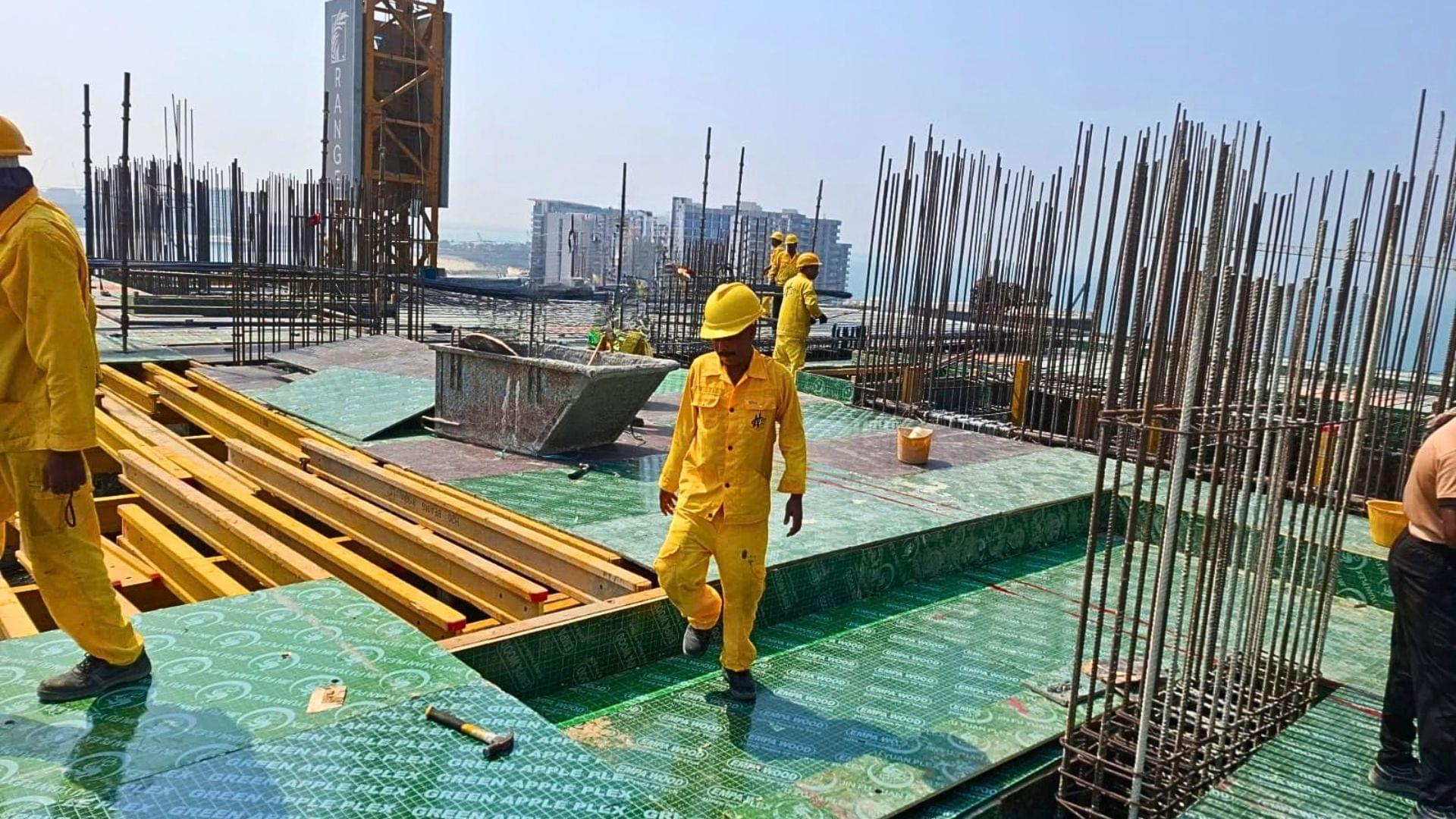

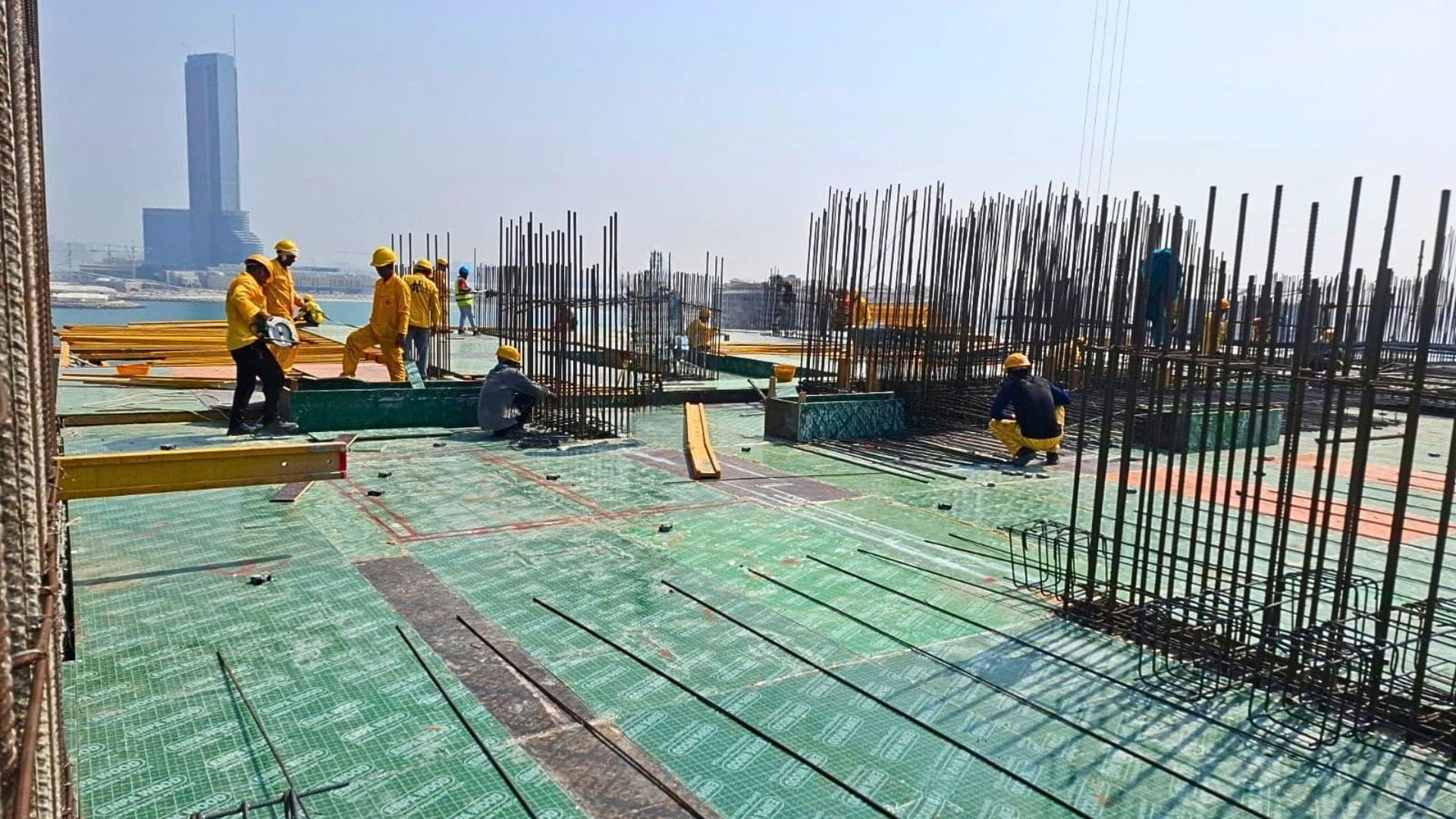

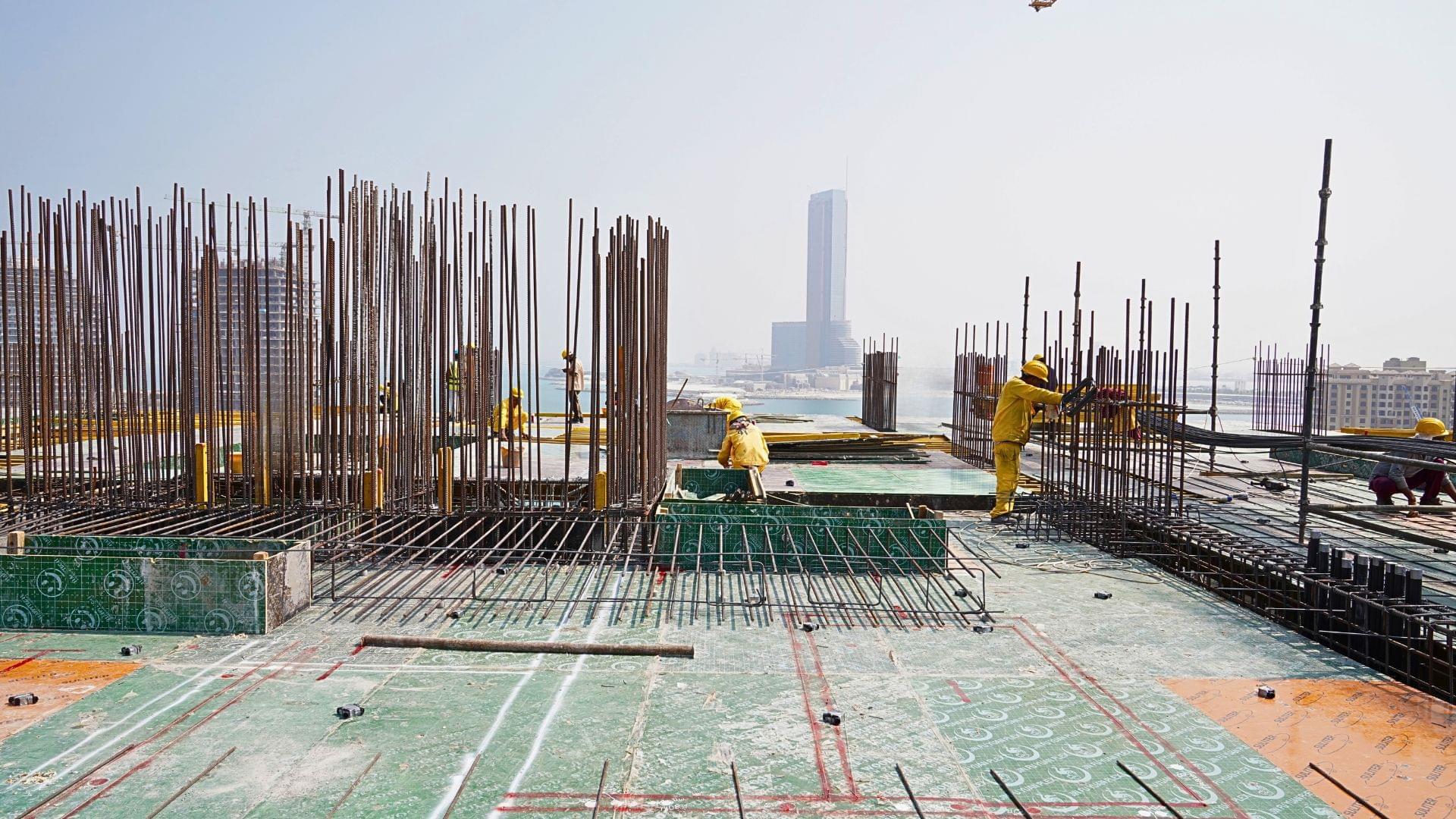

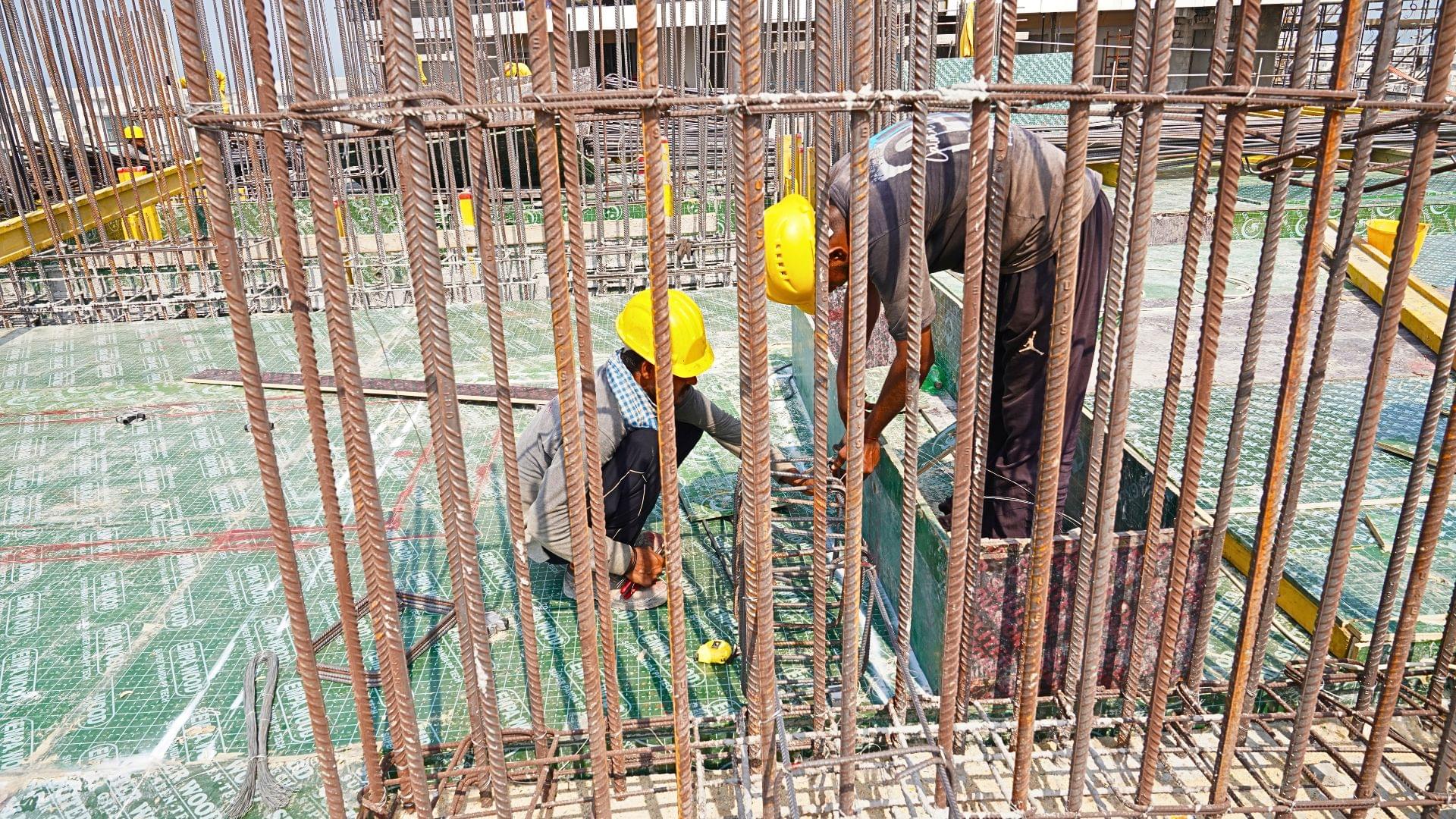

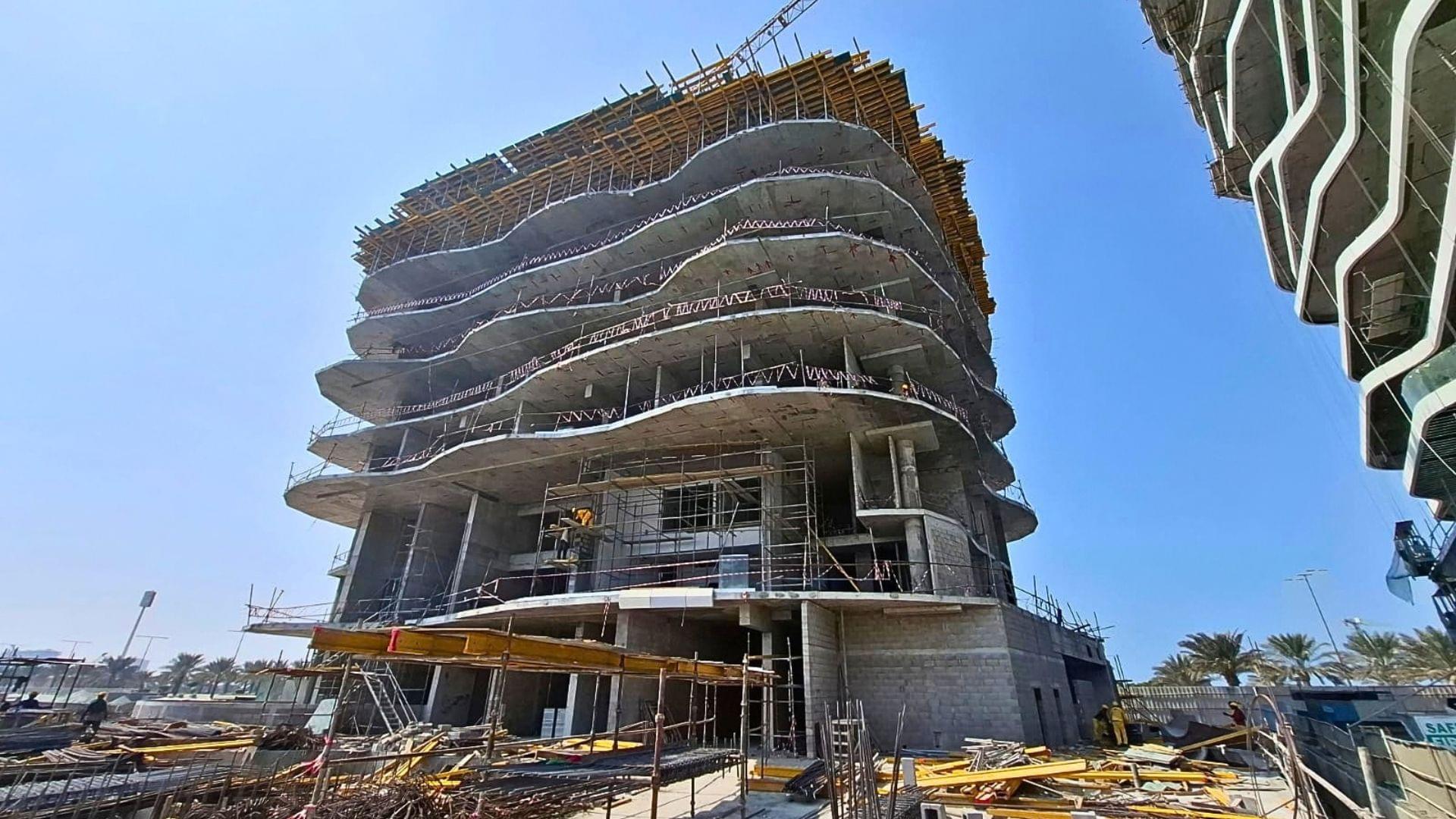

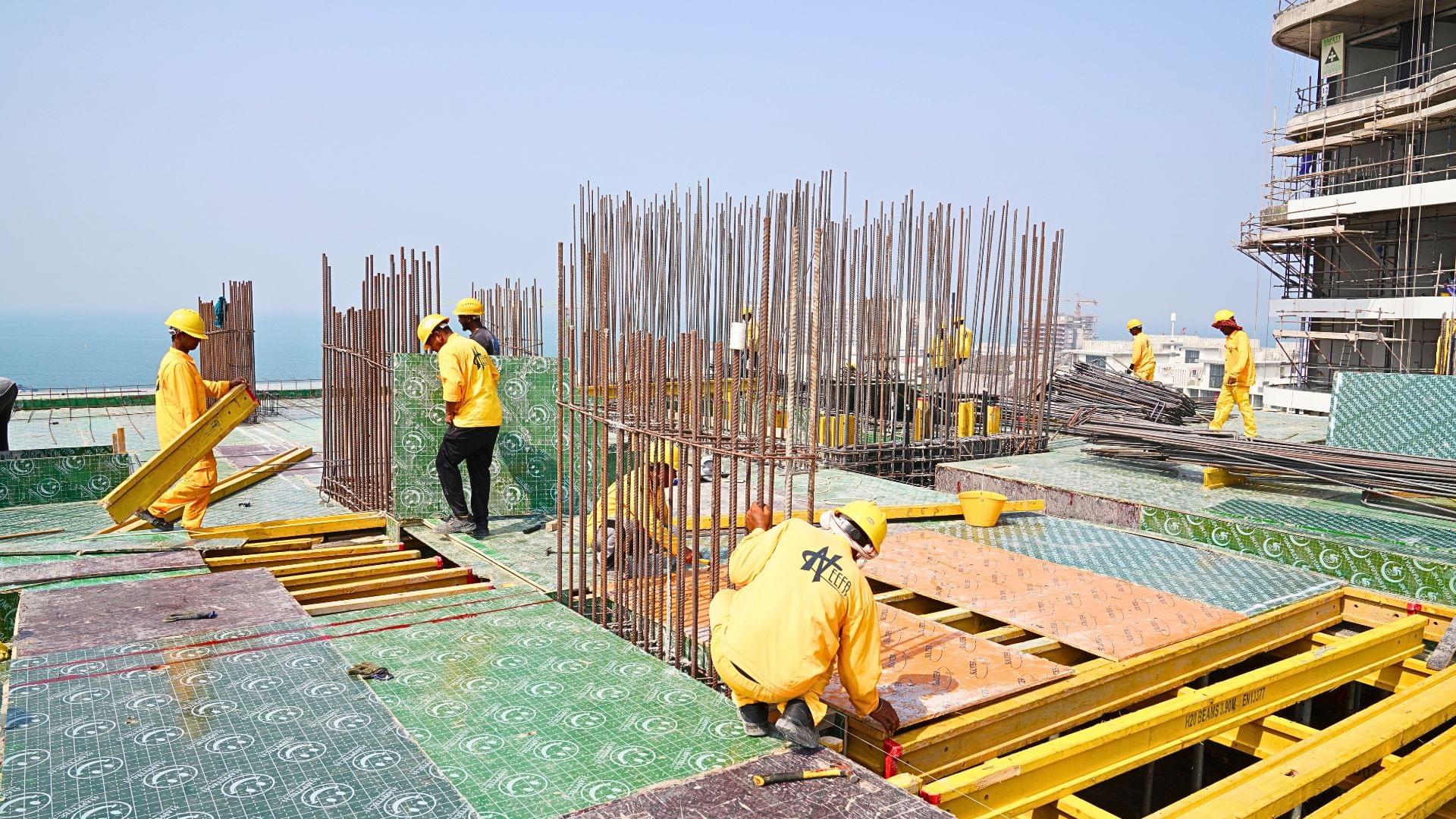

The Beach Vista Construction Updates Q2 2026

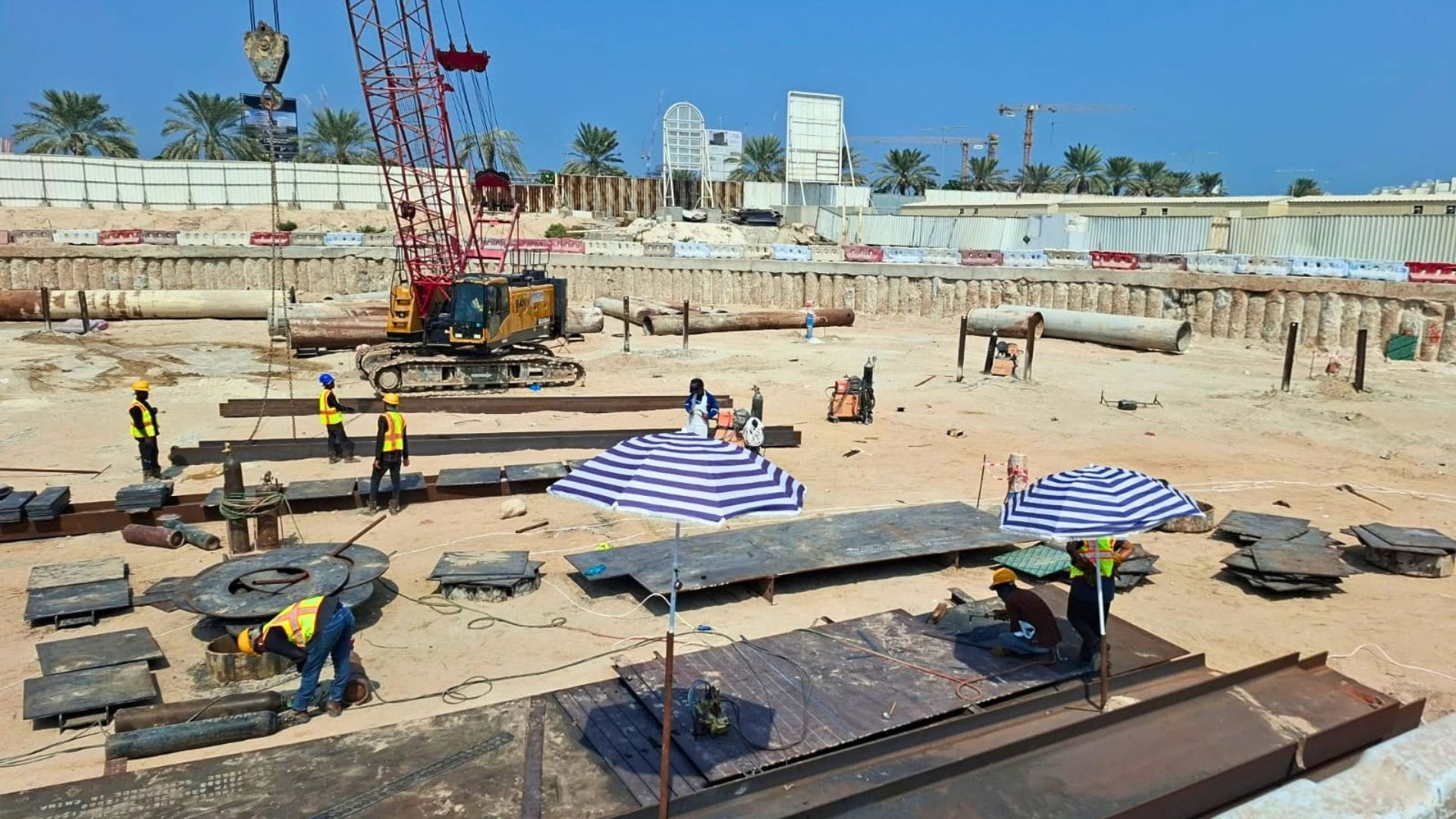

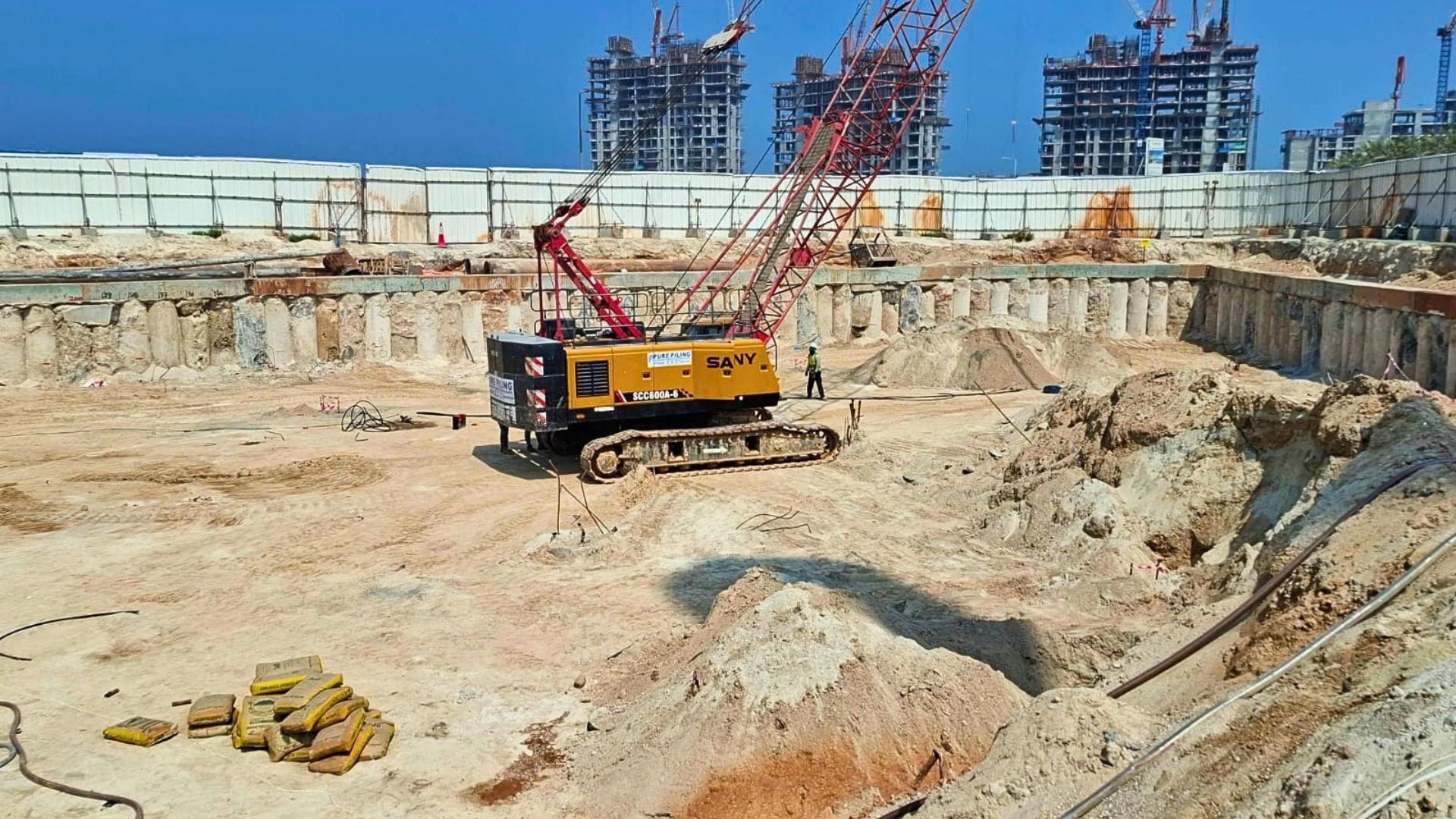

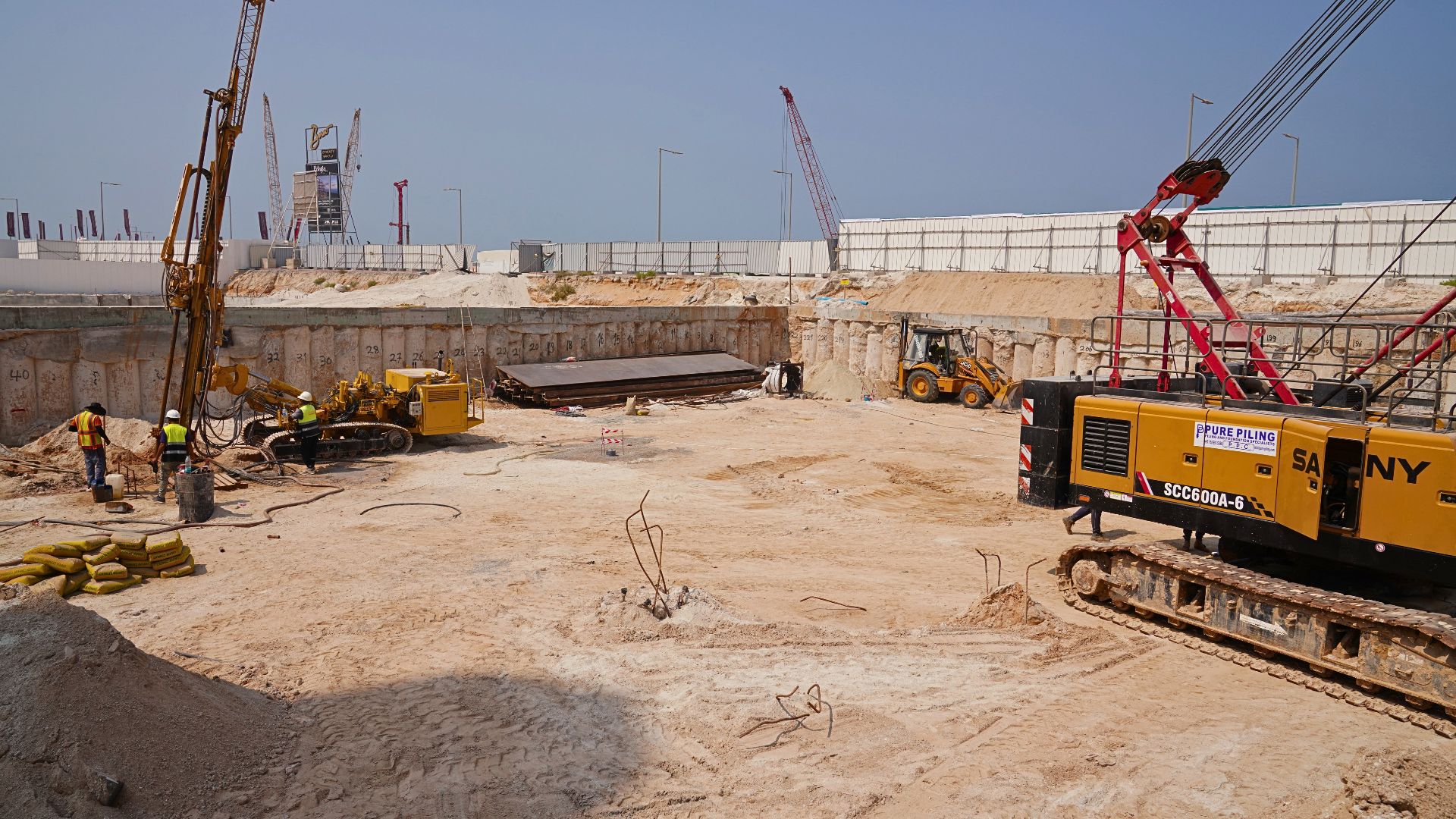

Master Developer Approval
:
Completed
Initial Architectural Approval (RAKM)
:
Completed
Shoring System
:
90% Completed
Initial design approval(RAKM)
:
100%
Enabling Works & Site Mobilization
:
Completed
Soil Investigation
:
Completed
Soil Improvement
:
Completed
NOC (RAKM) for piling works is obtained
:
100%

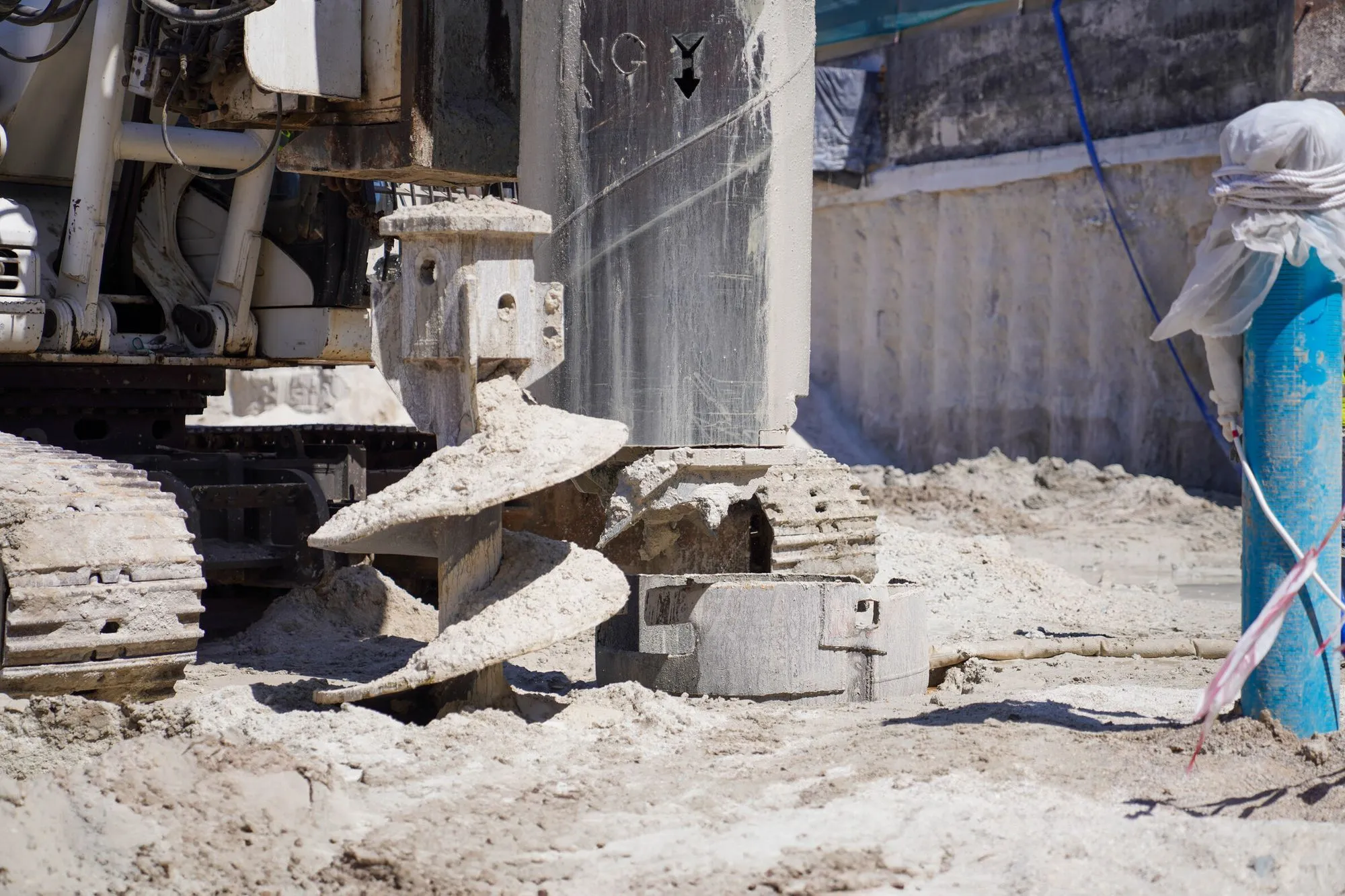

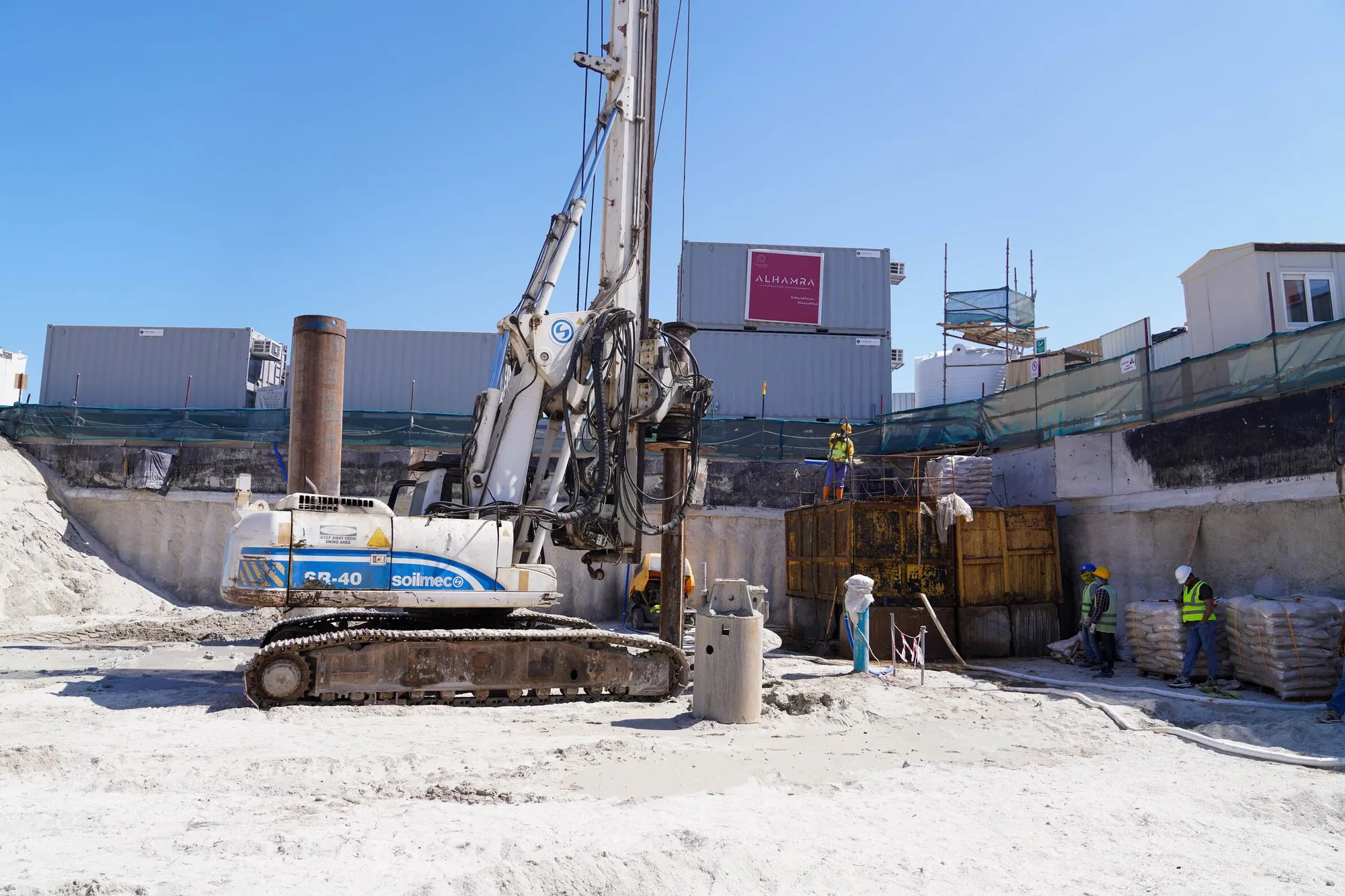

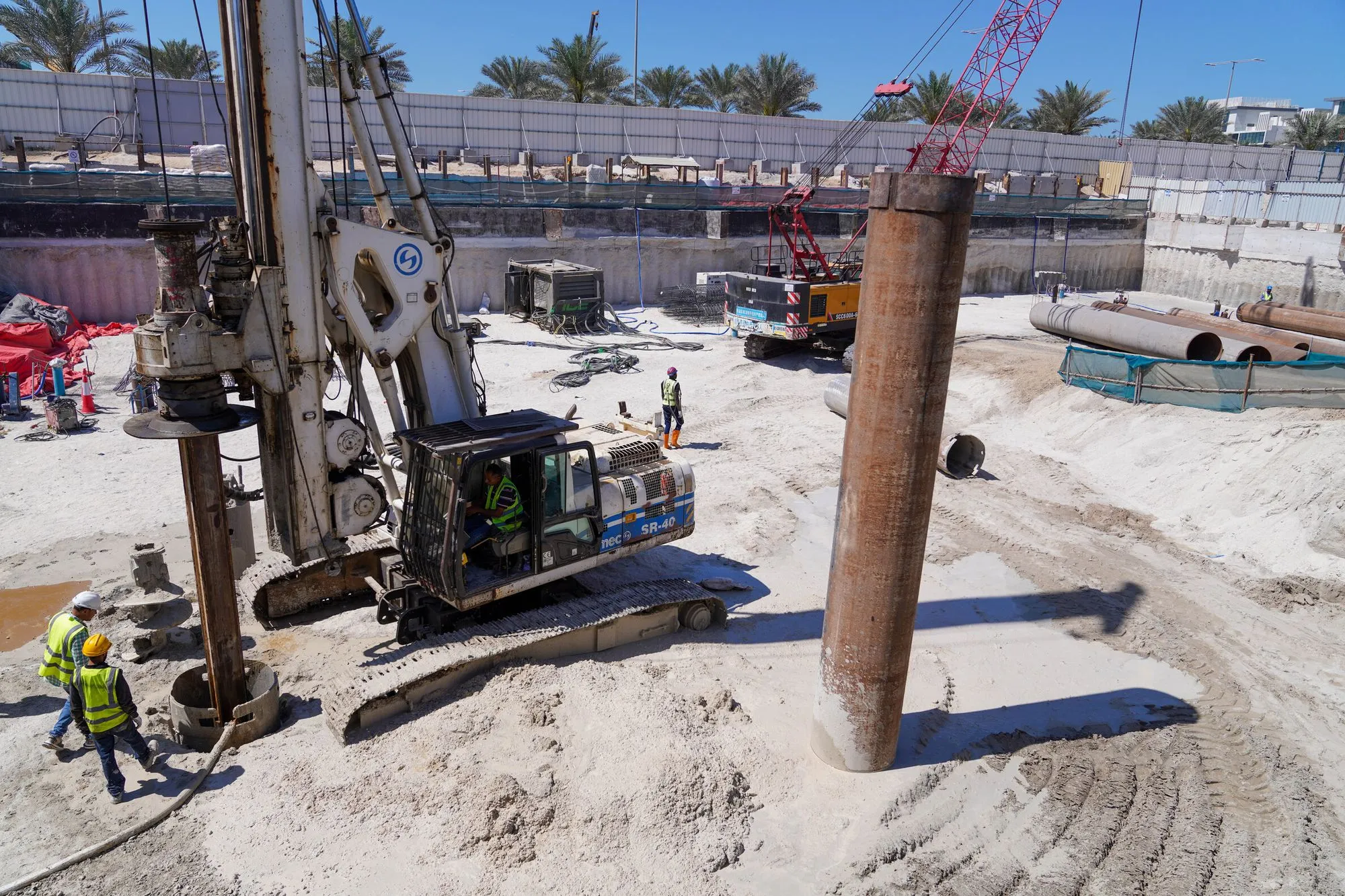

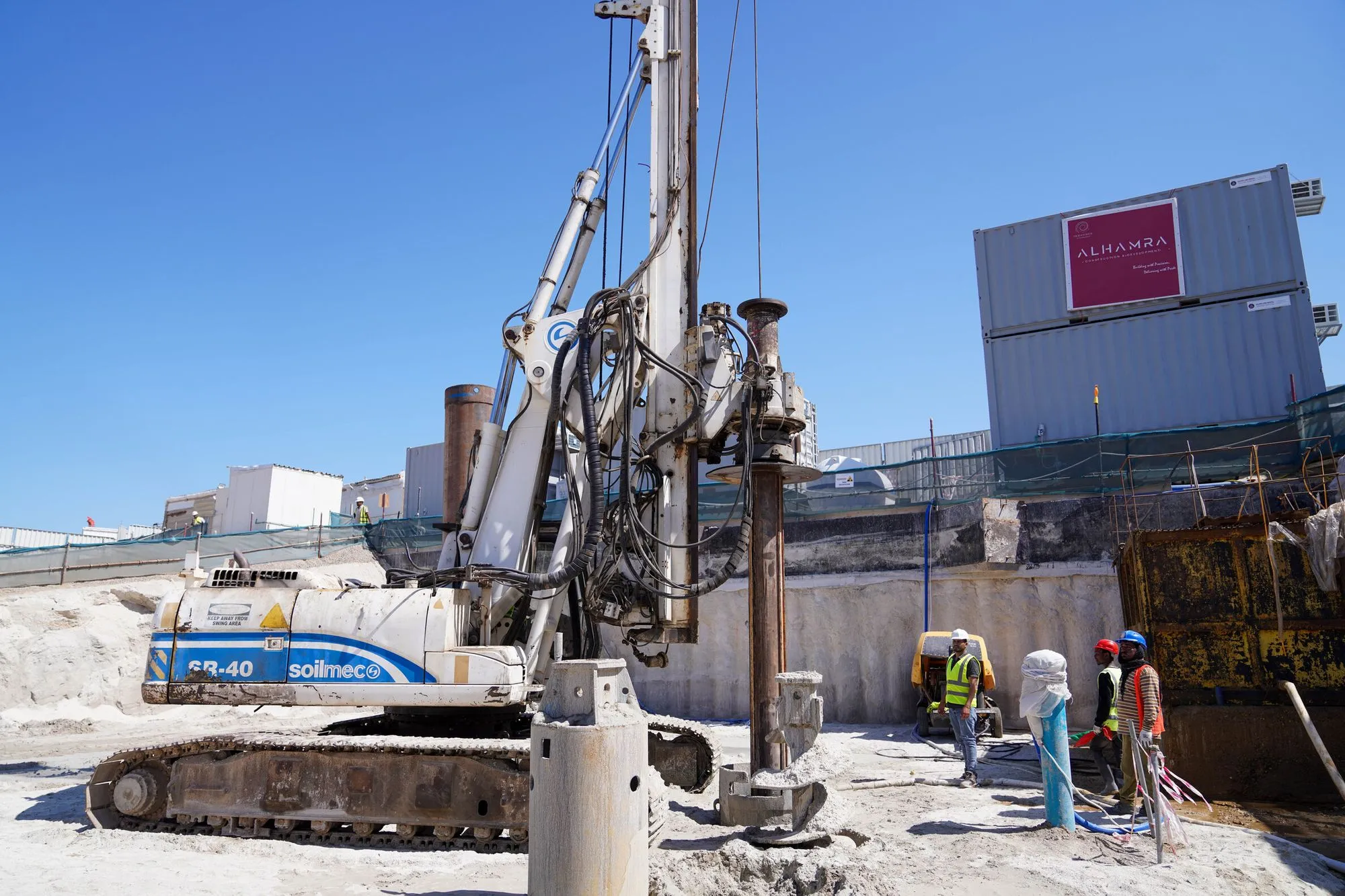

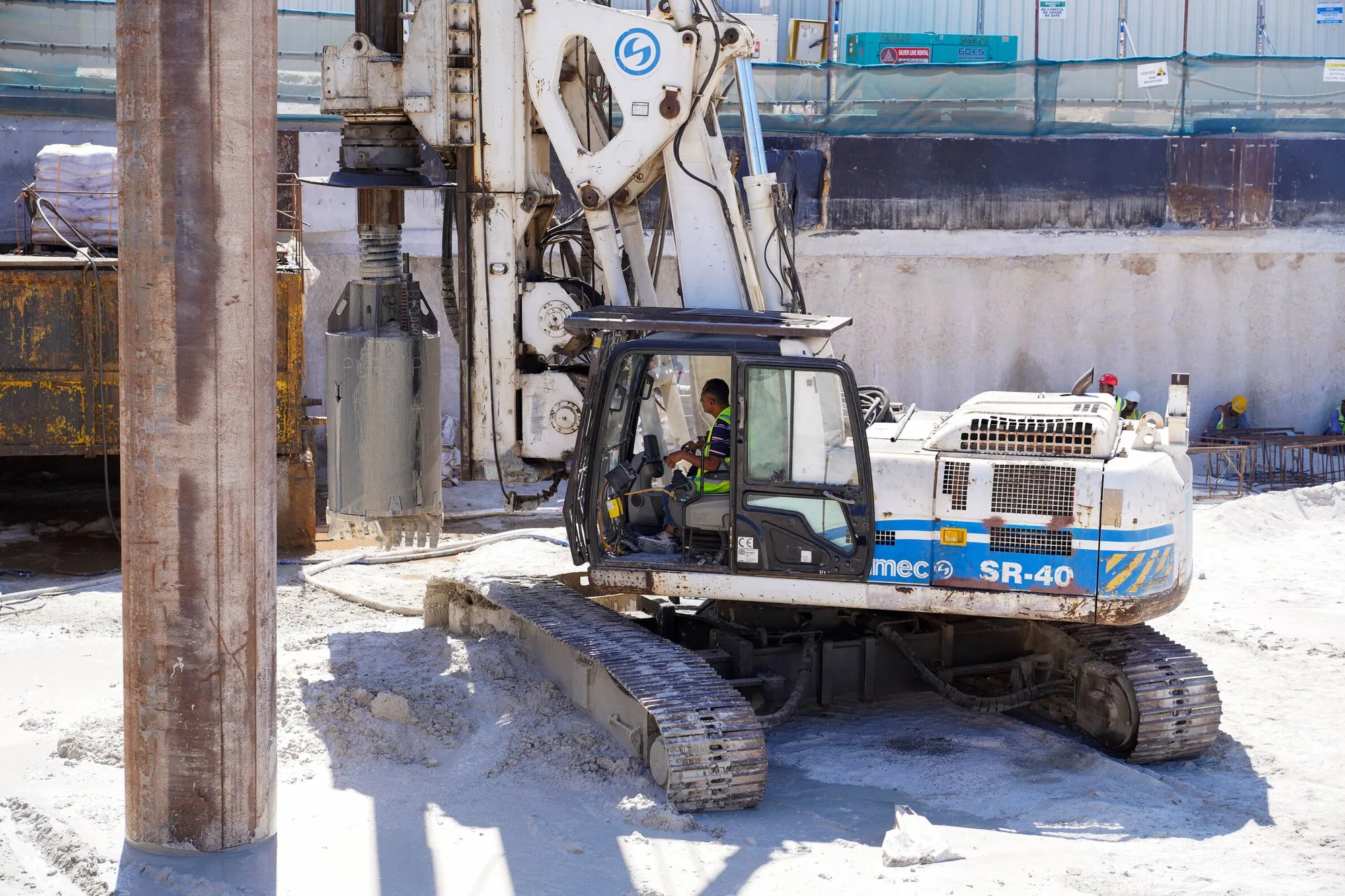

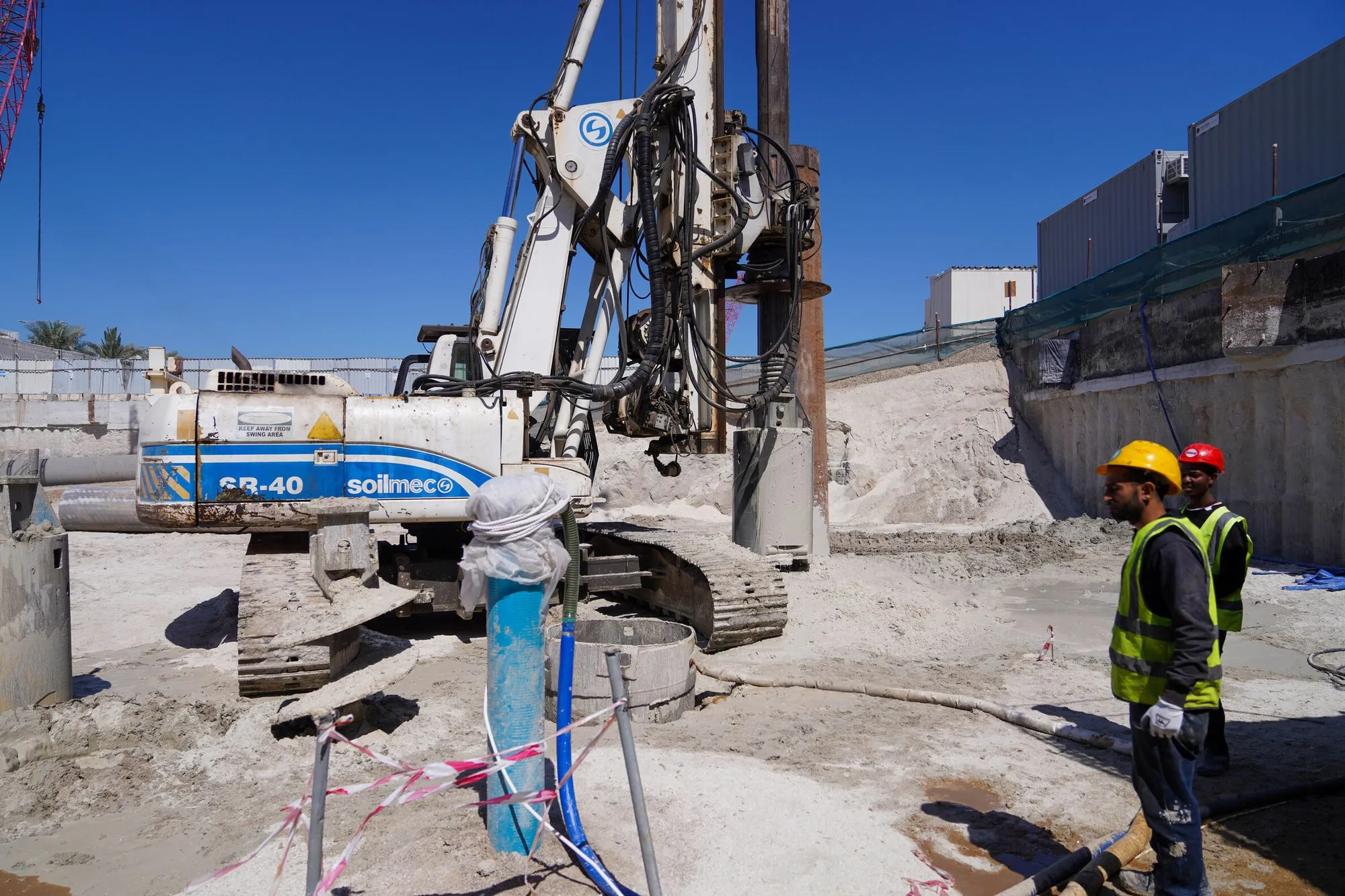

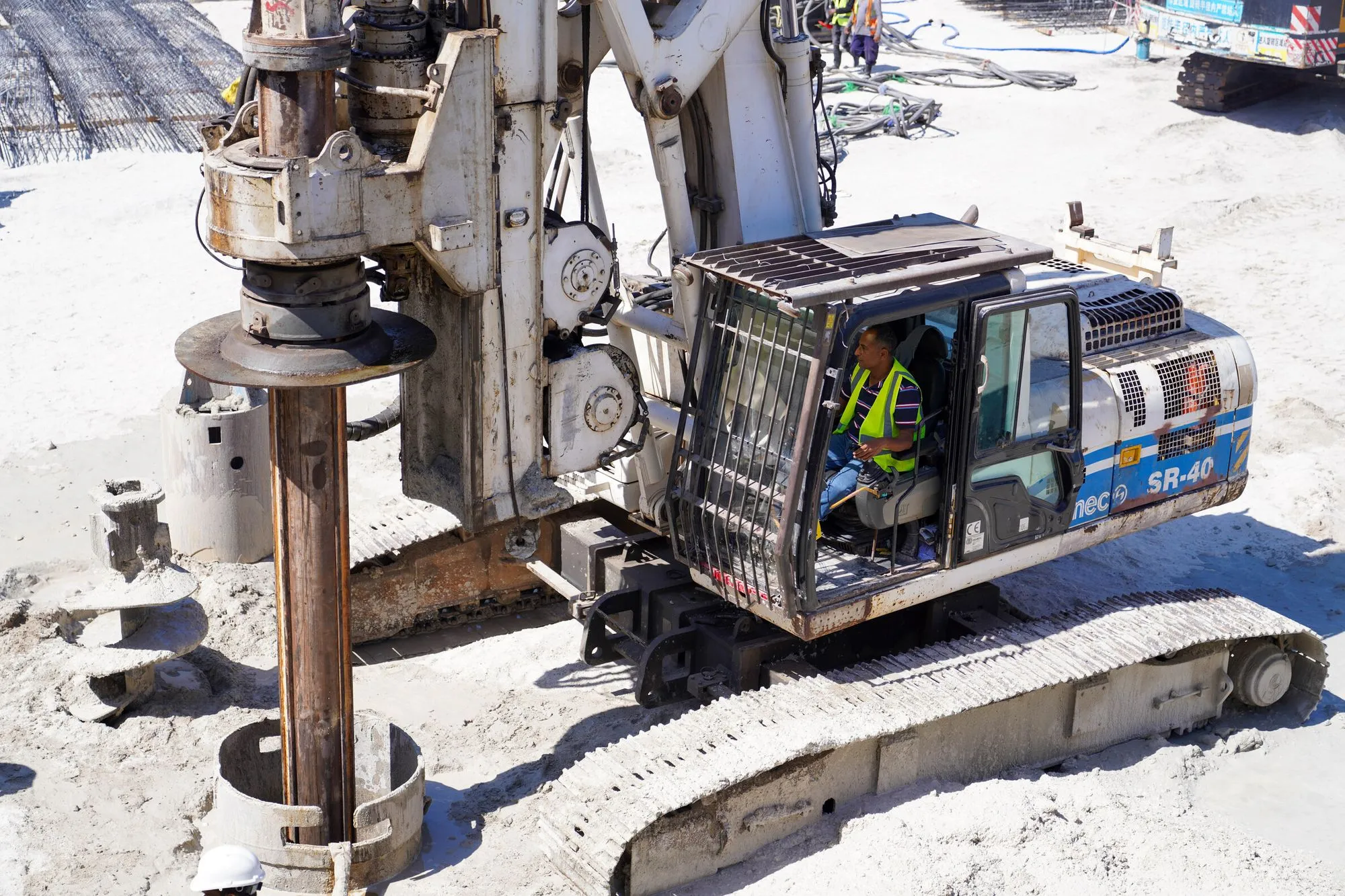

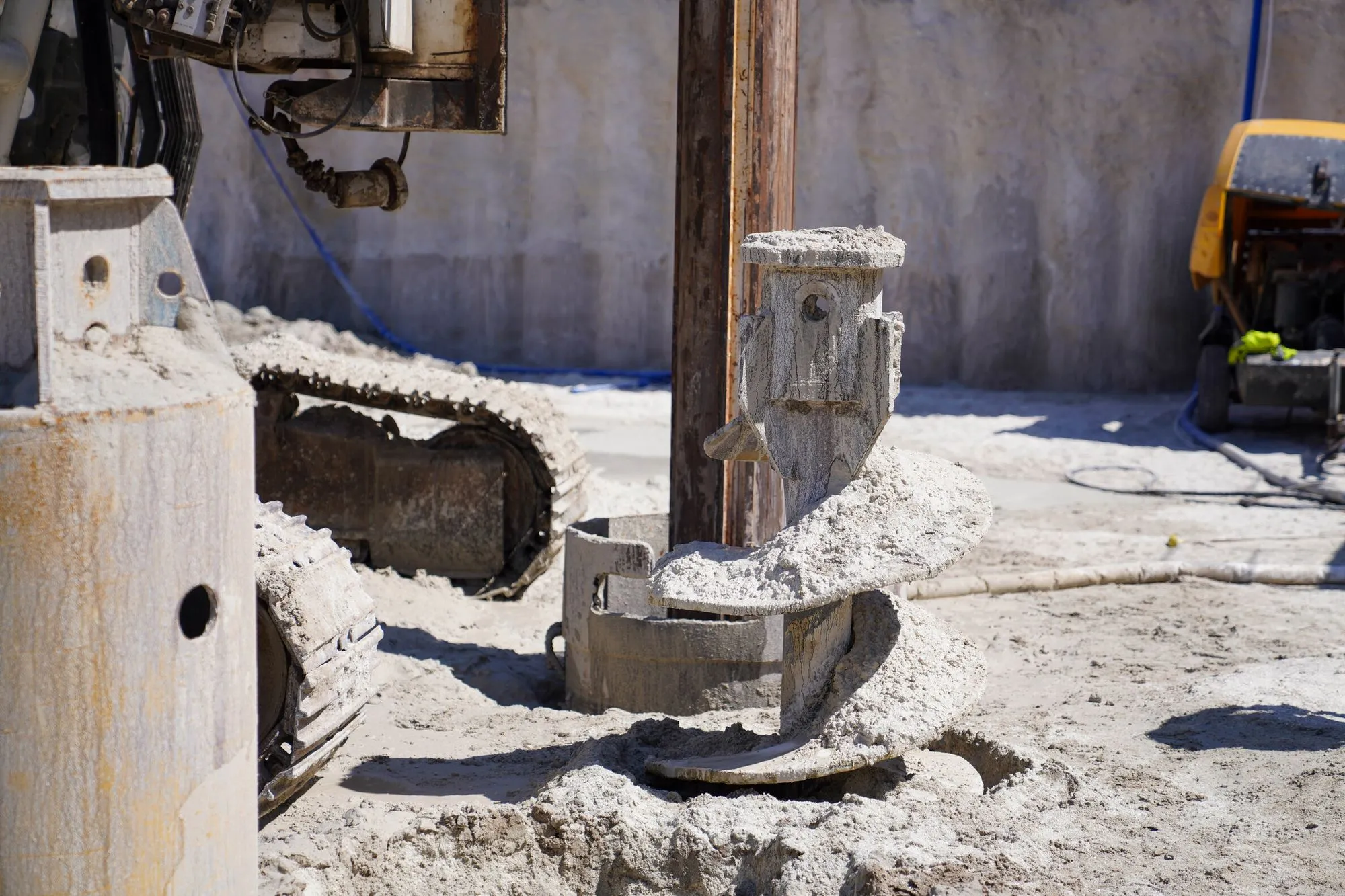

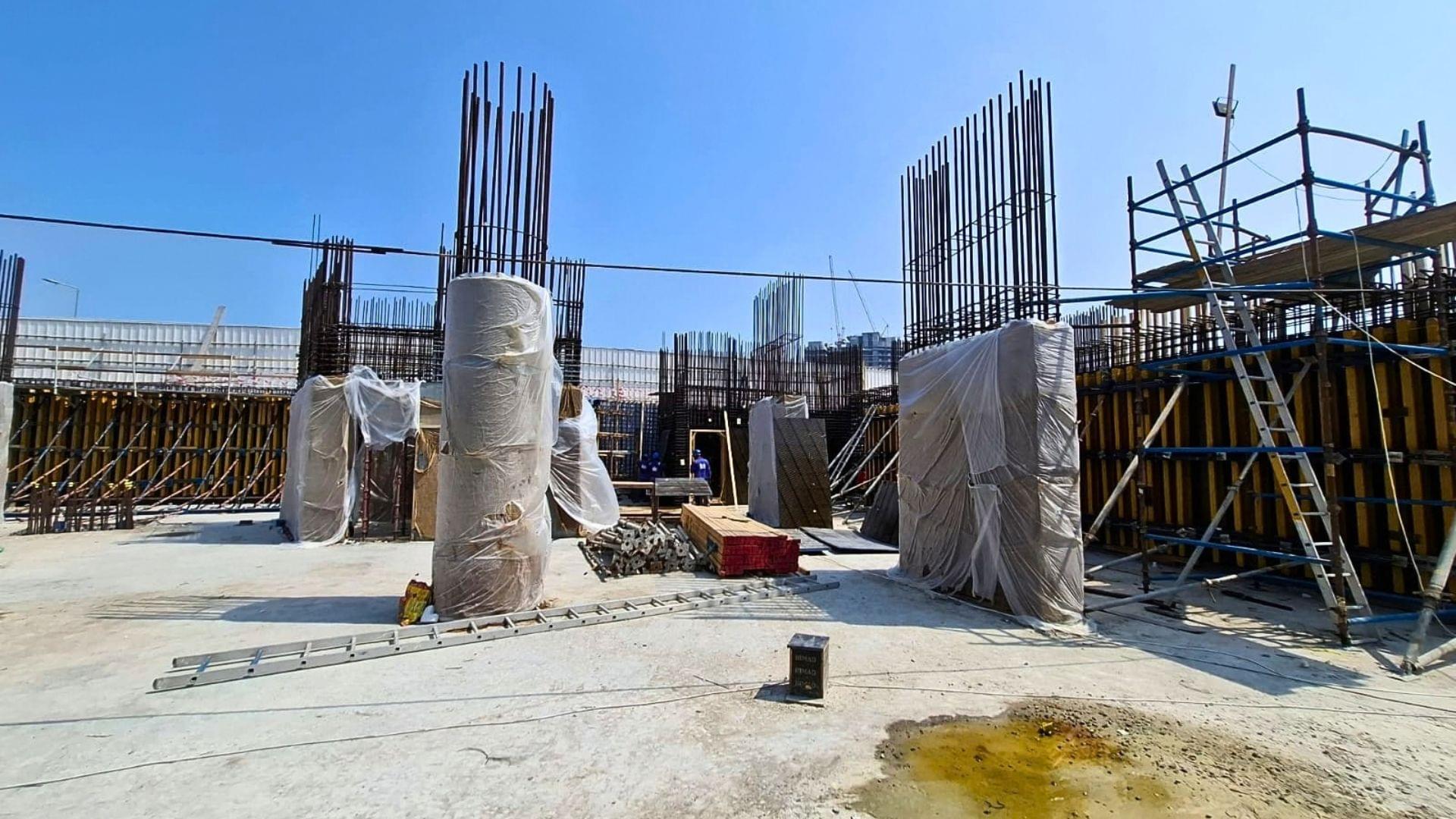

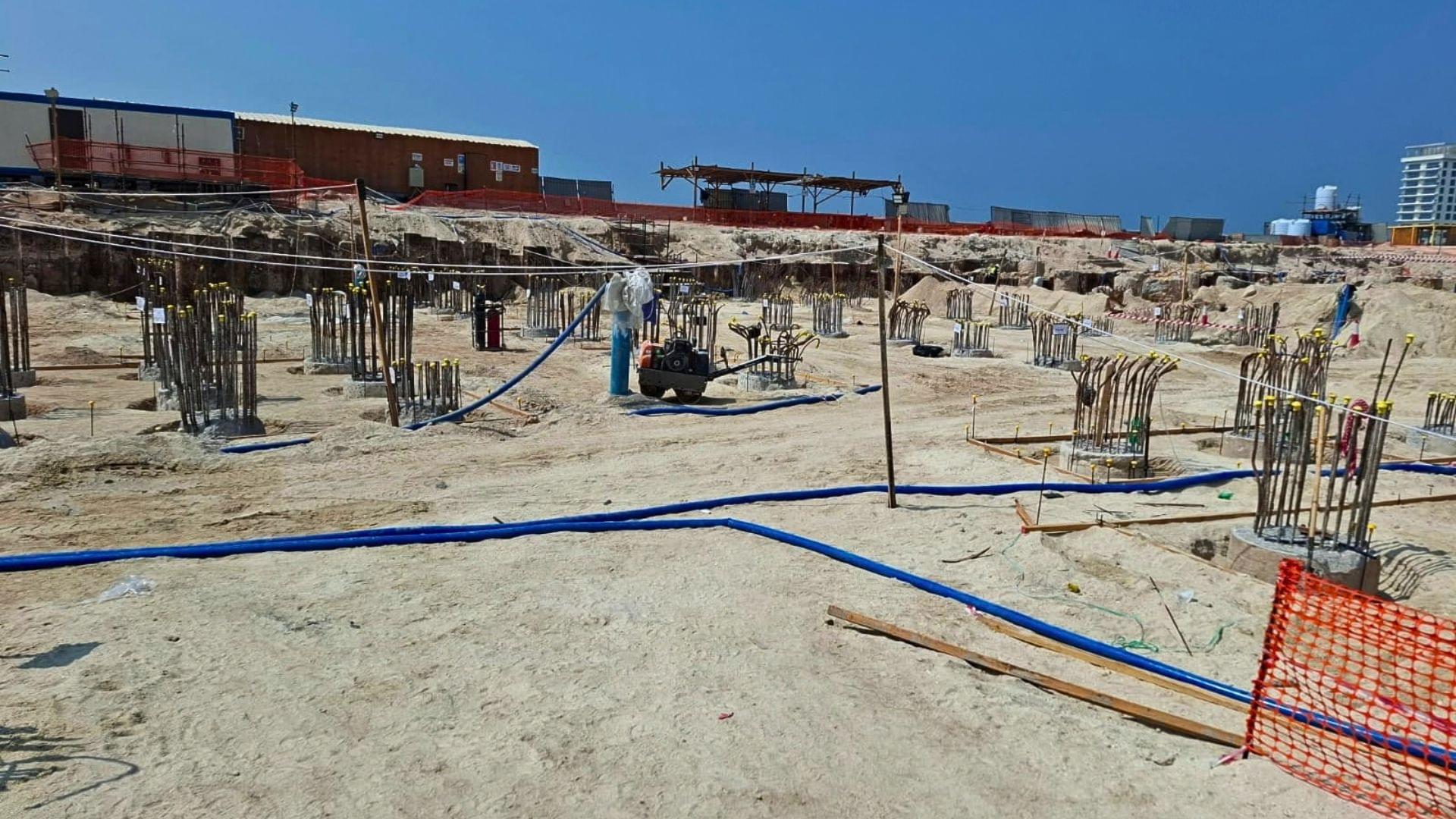

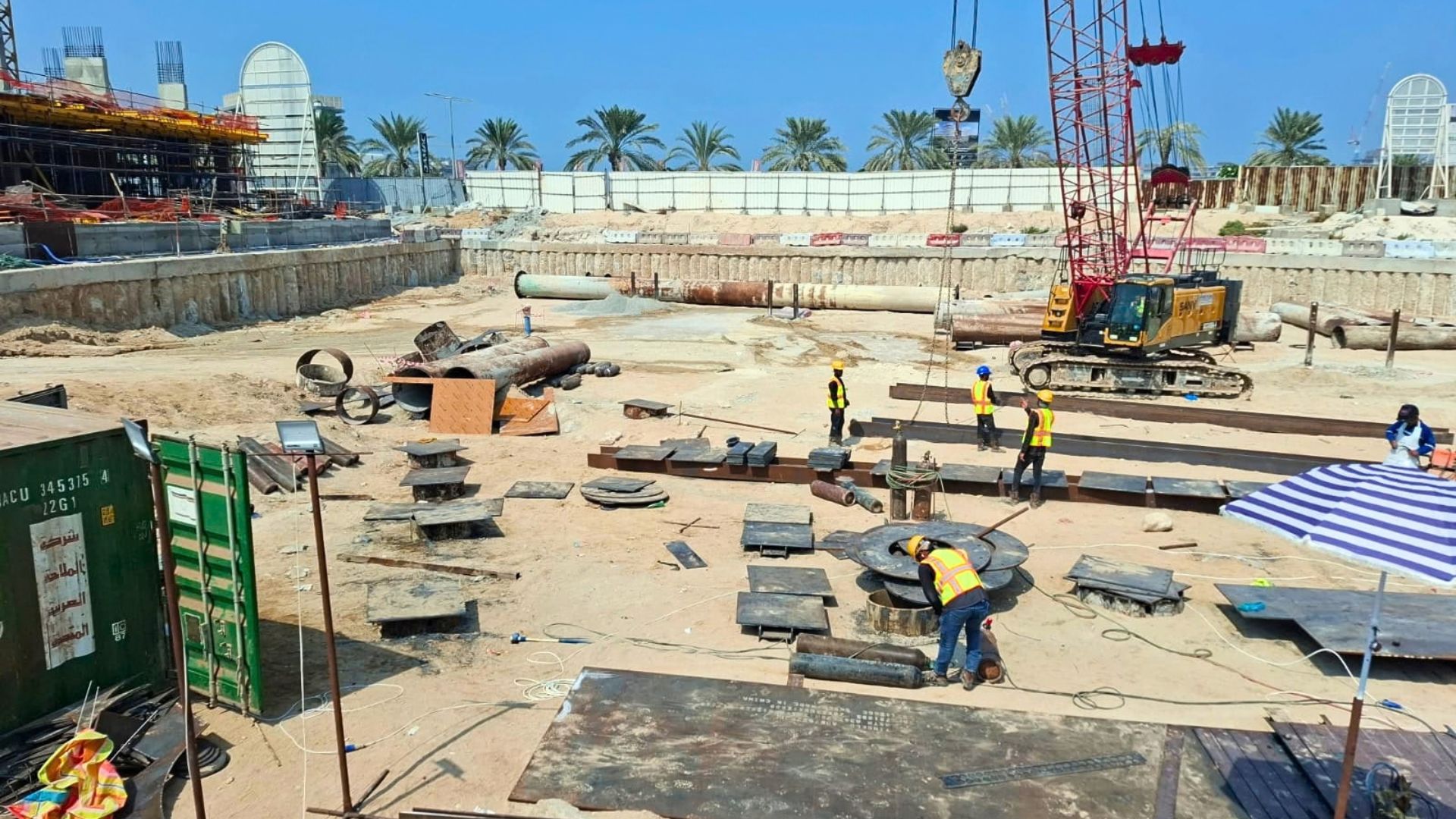

Piling works
:
35%
Design approval (RAKM) to obtain building permit RAKM
:
100%
View More
View Less

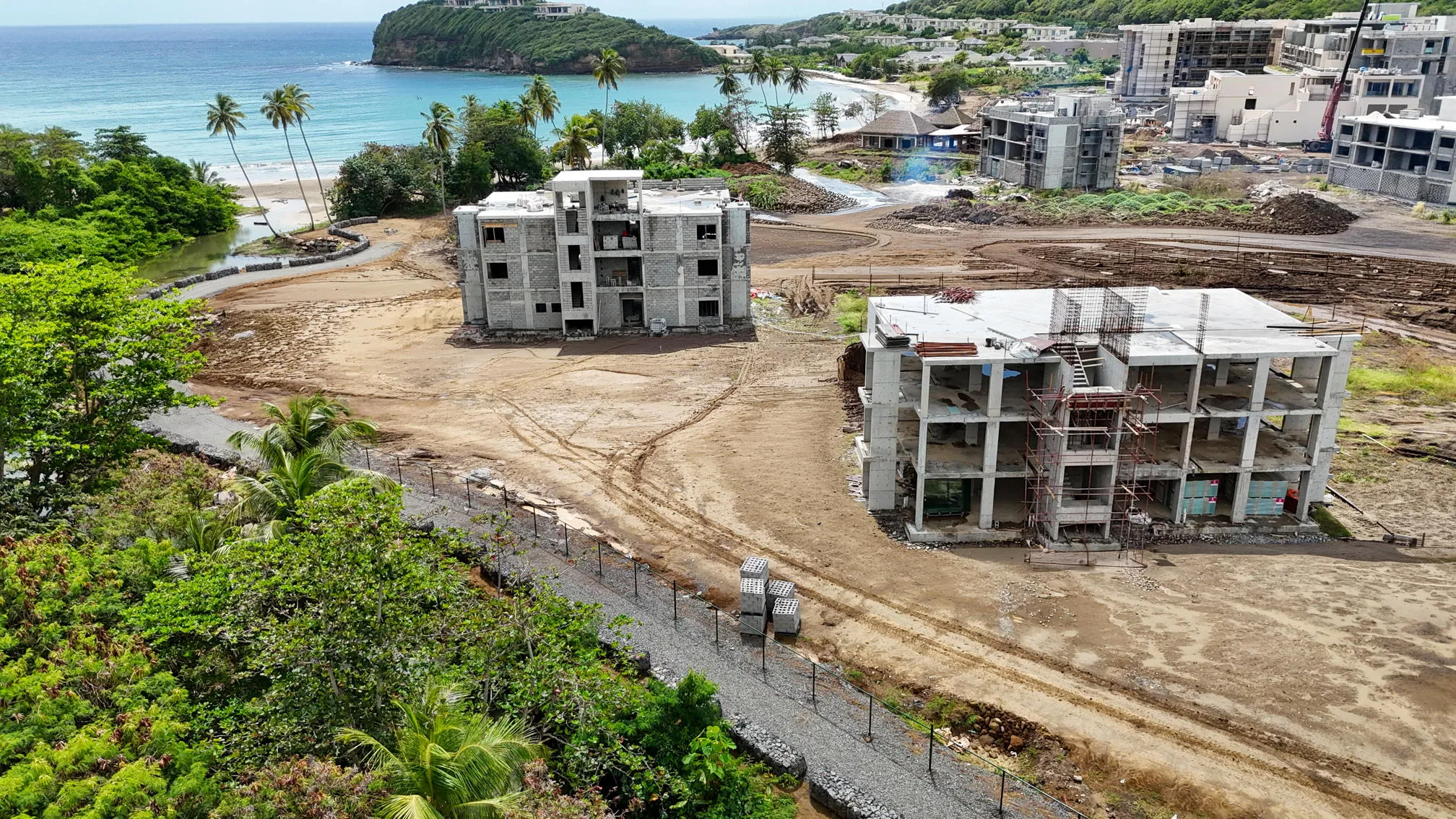

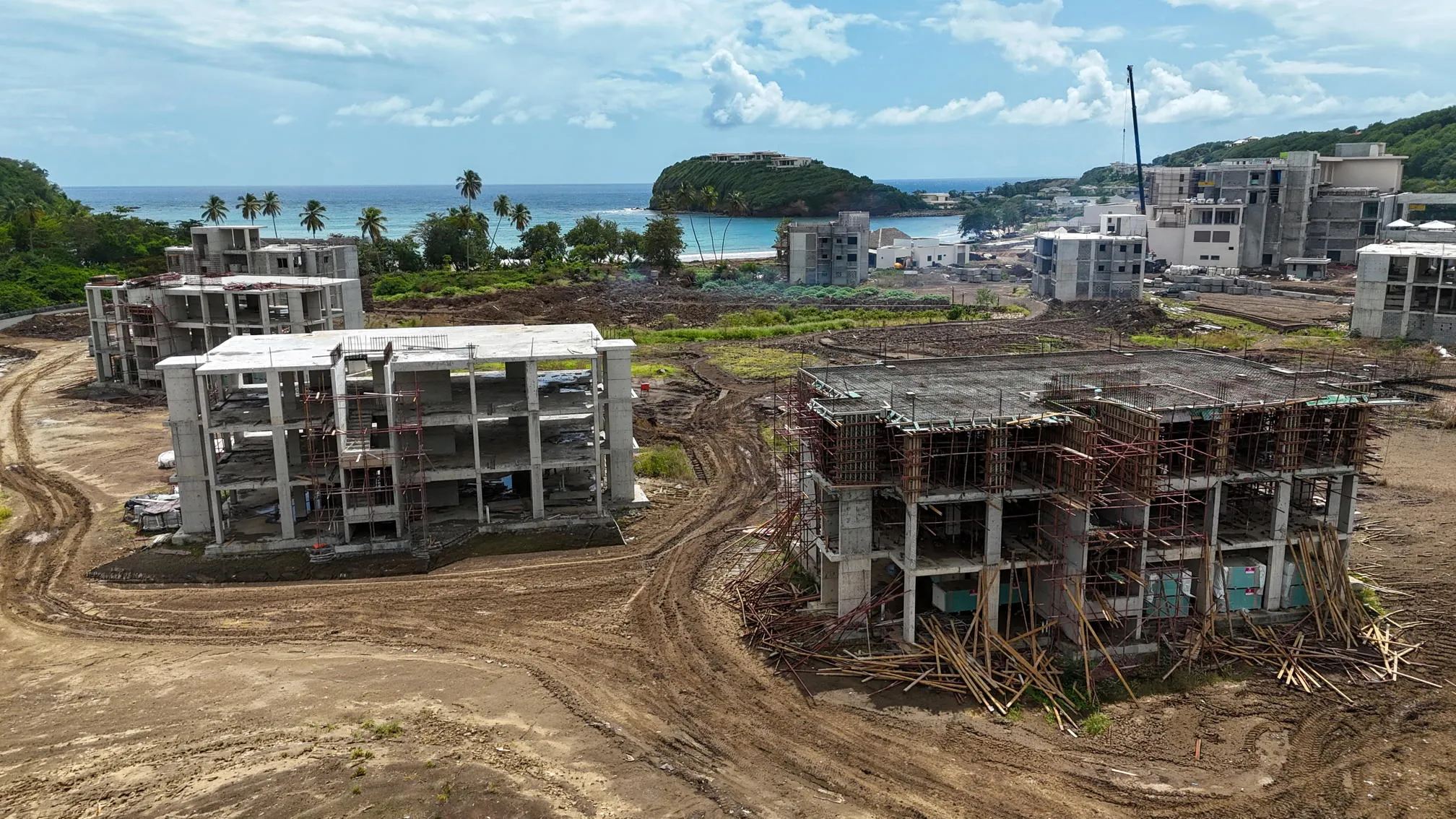

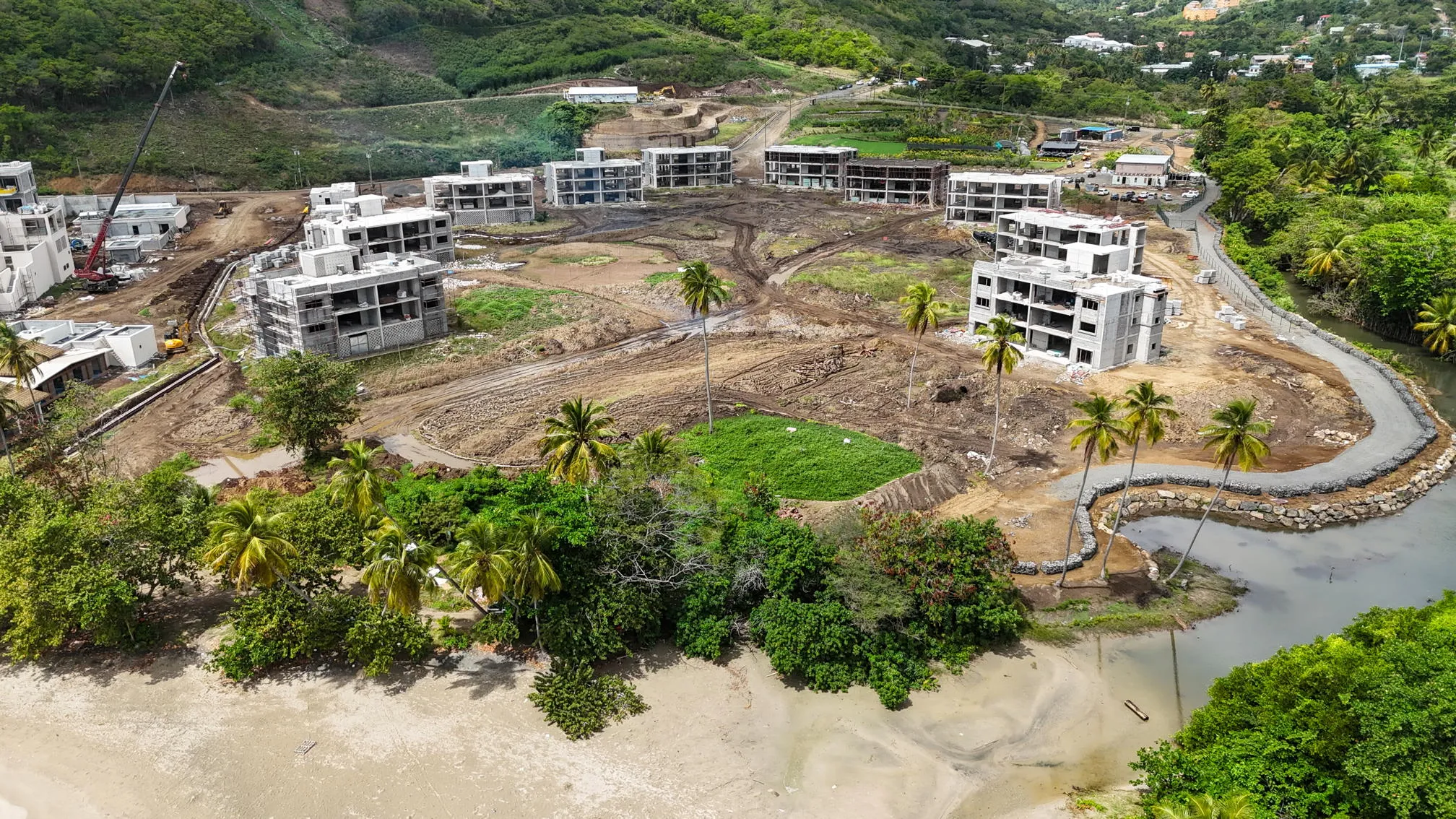

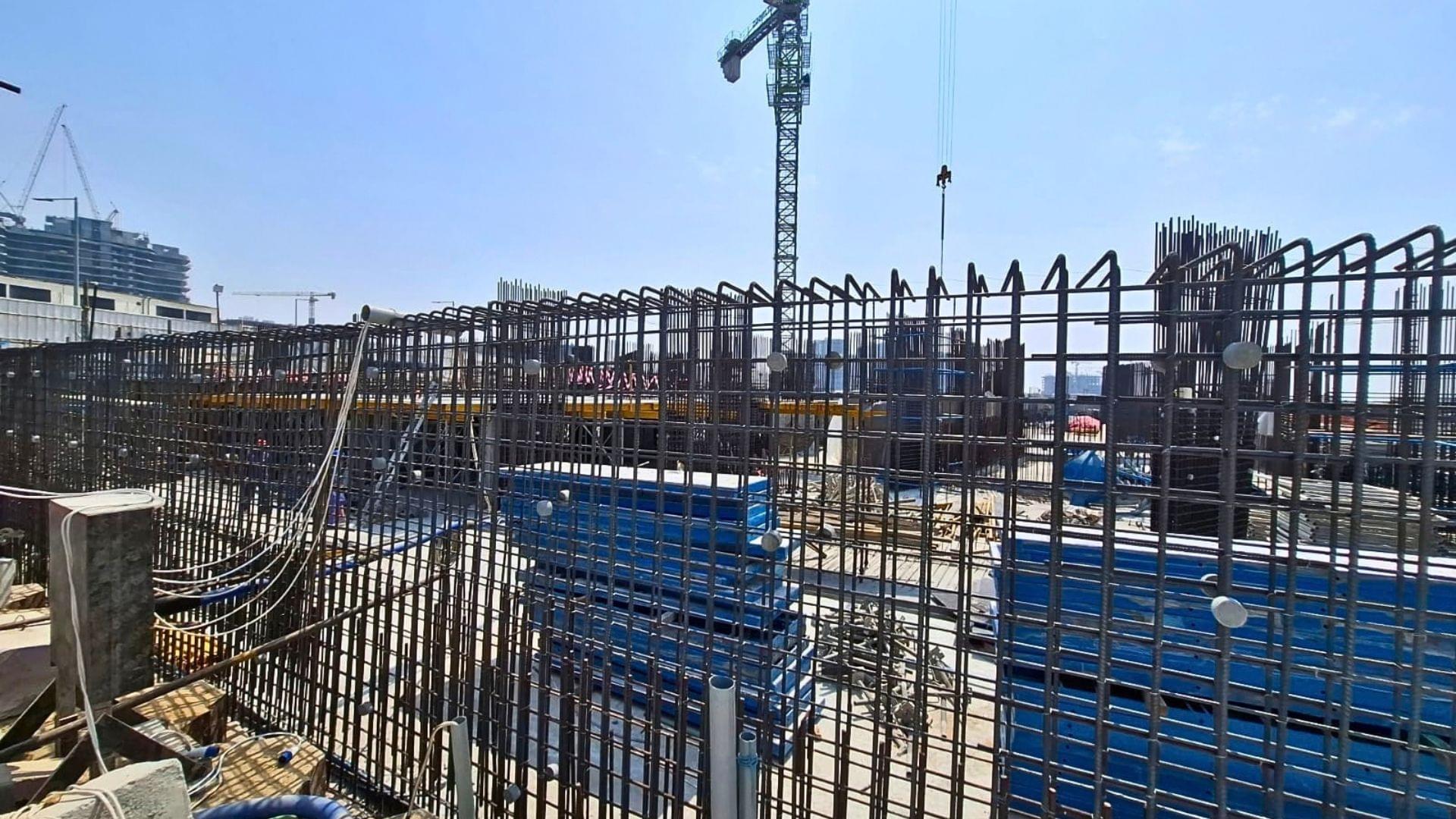

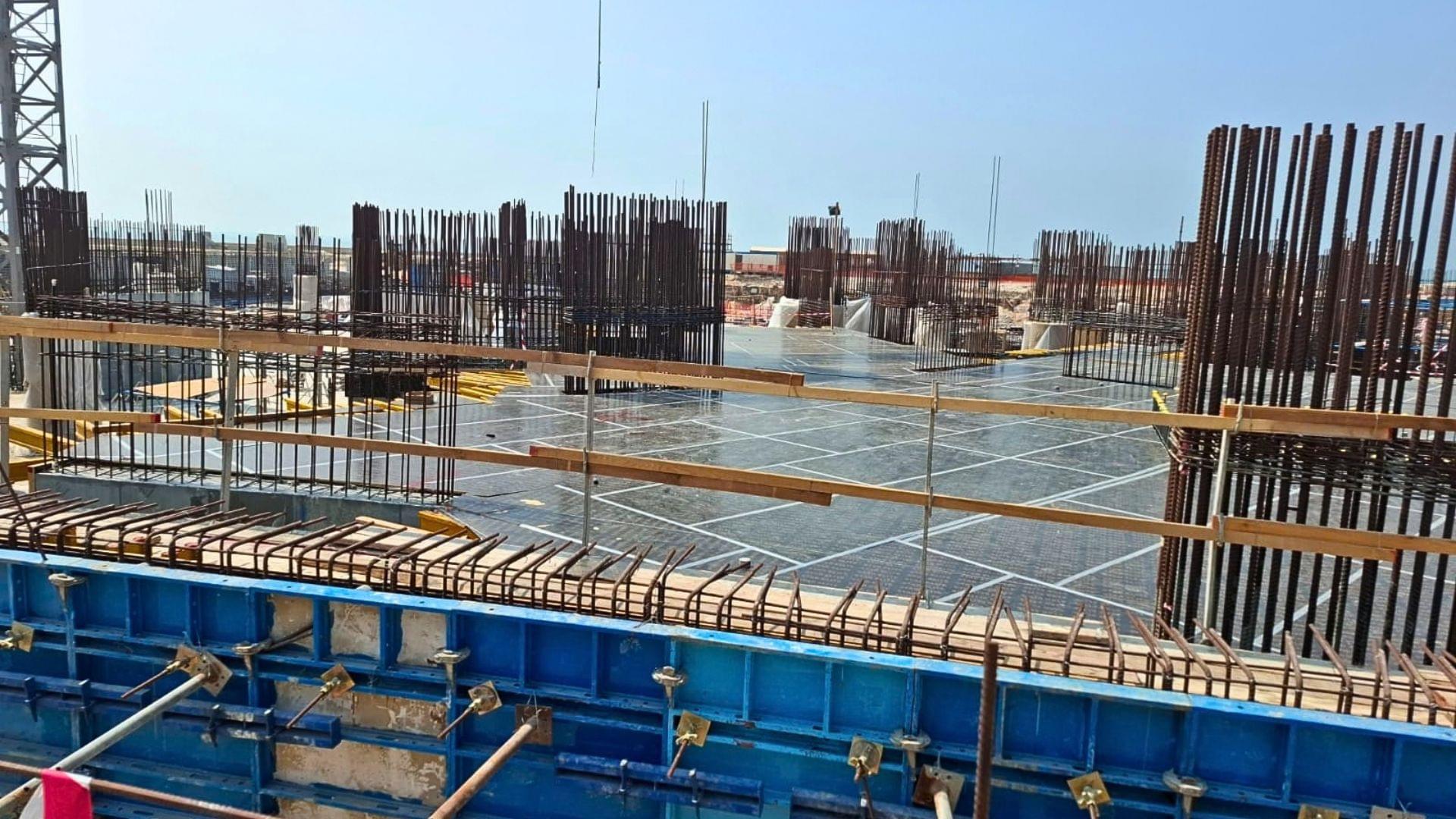

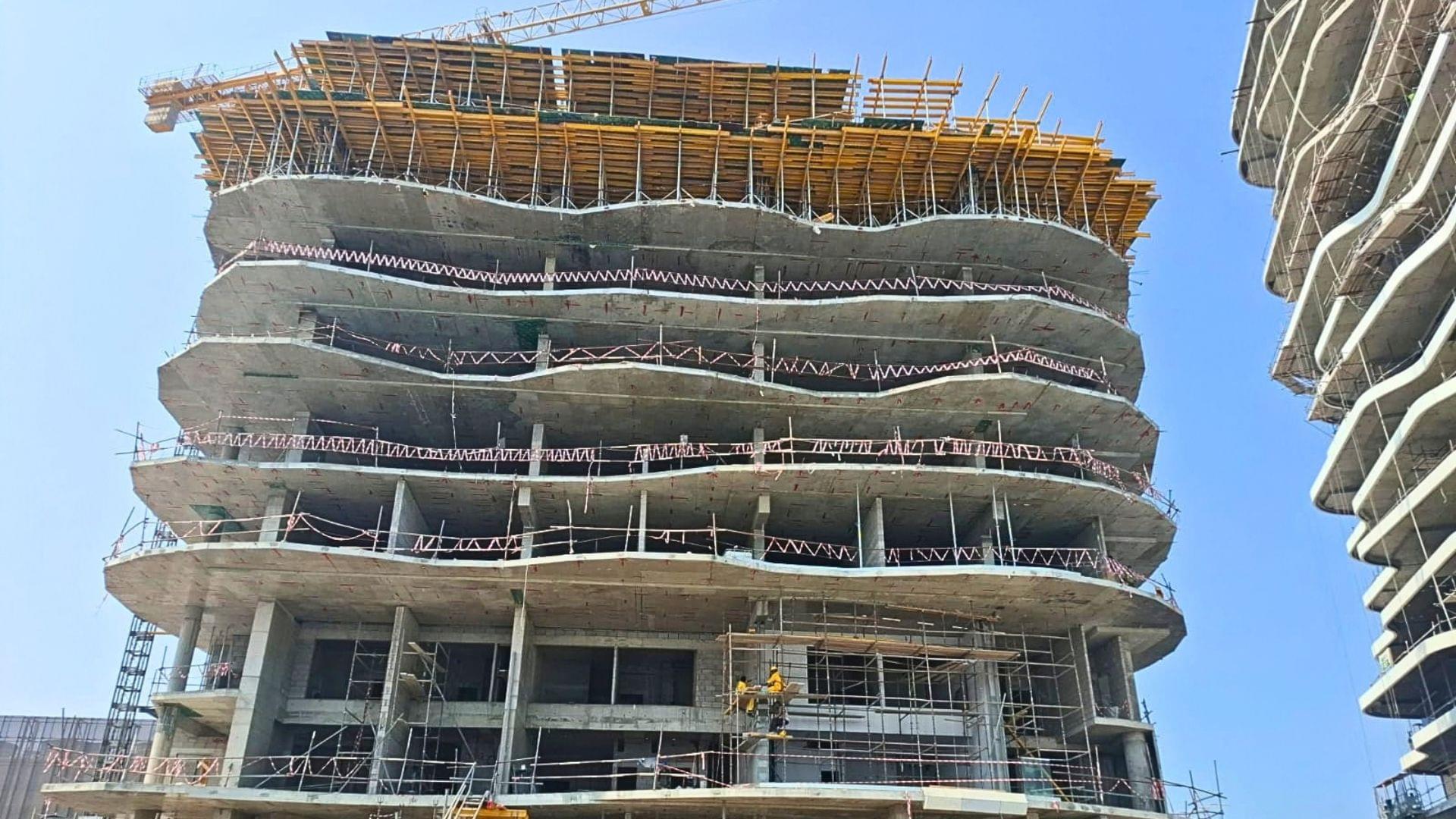

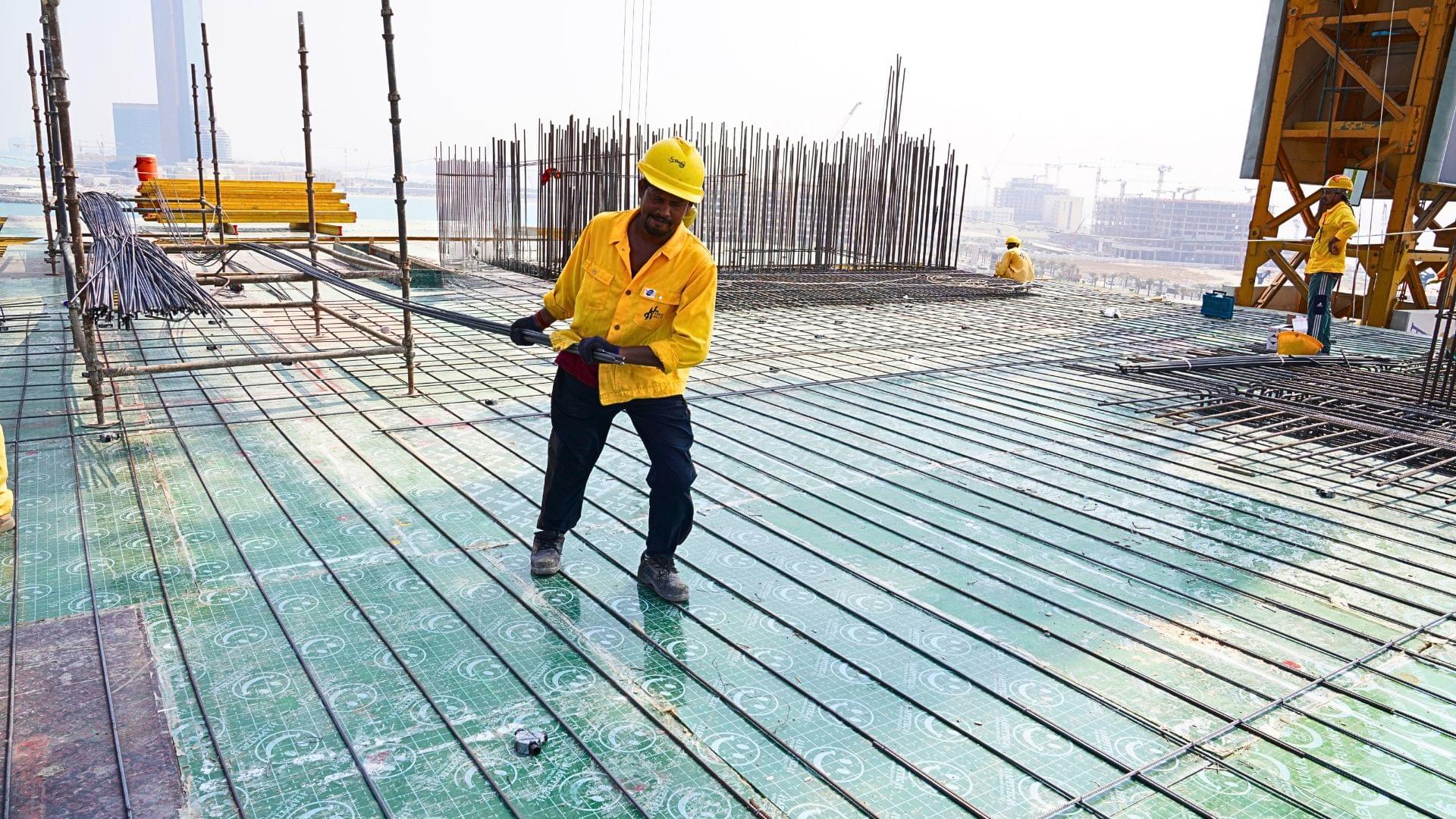

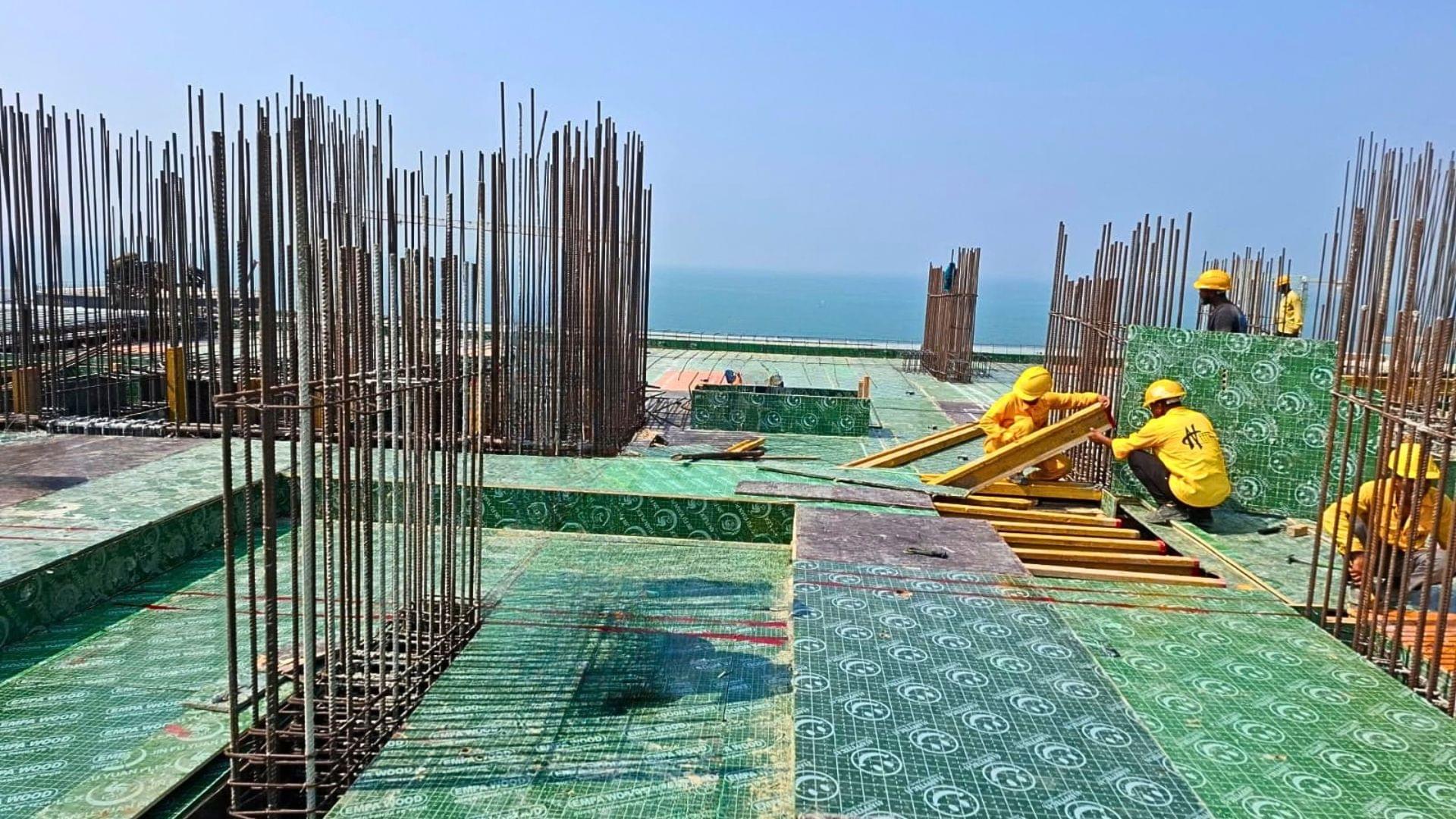

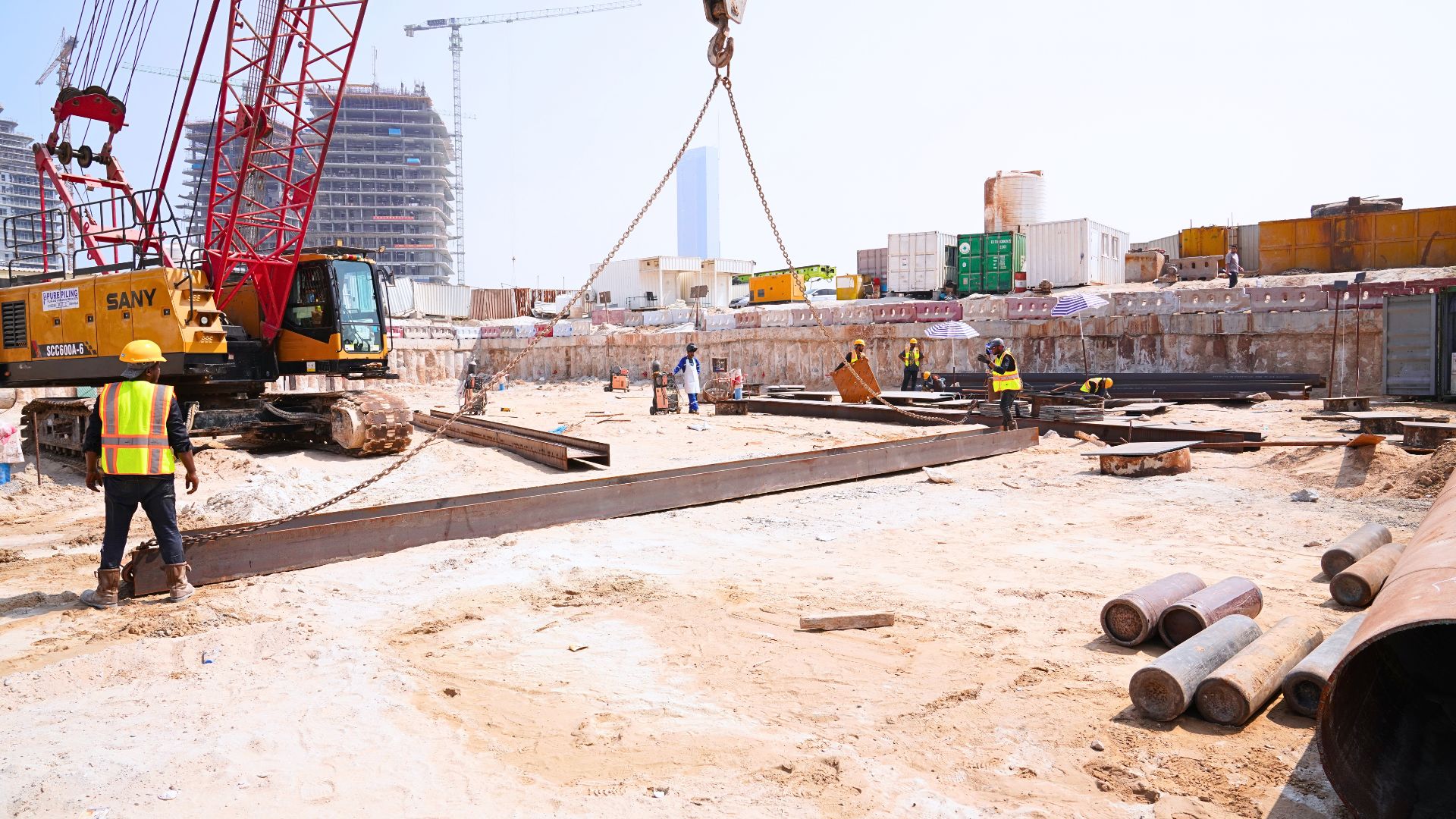

The Beach Vista
The Beach Residences

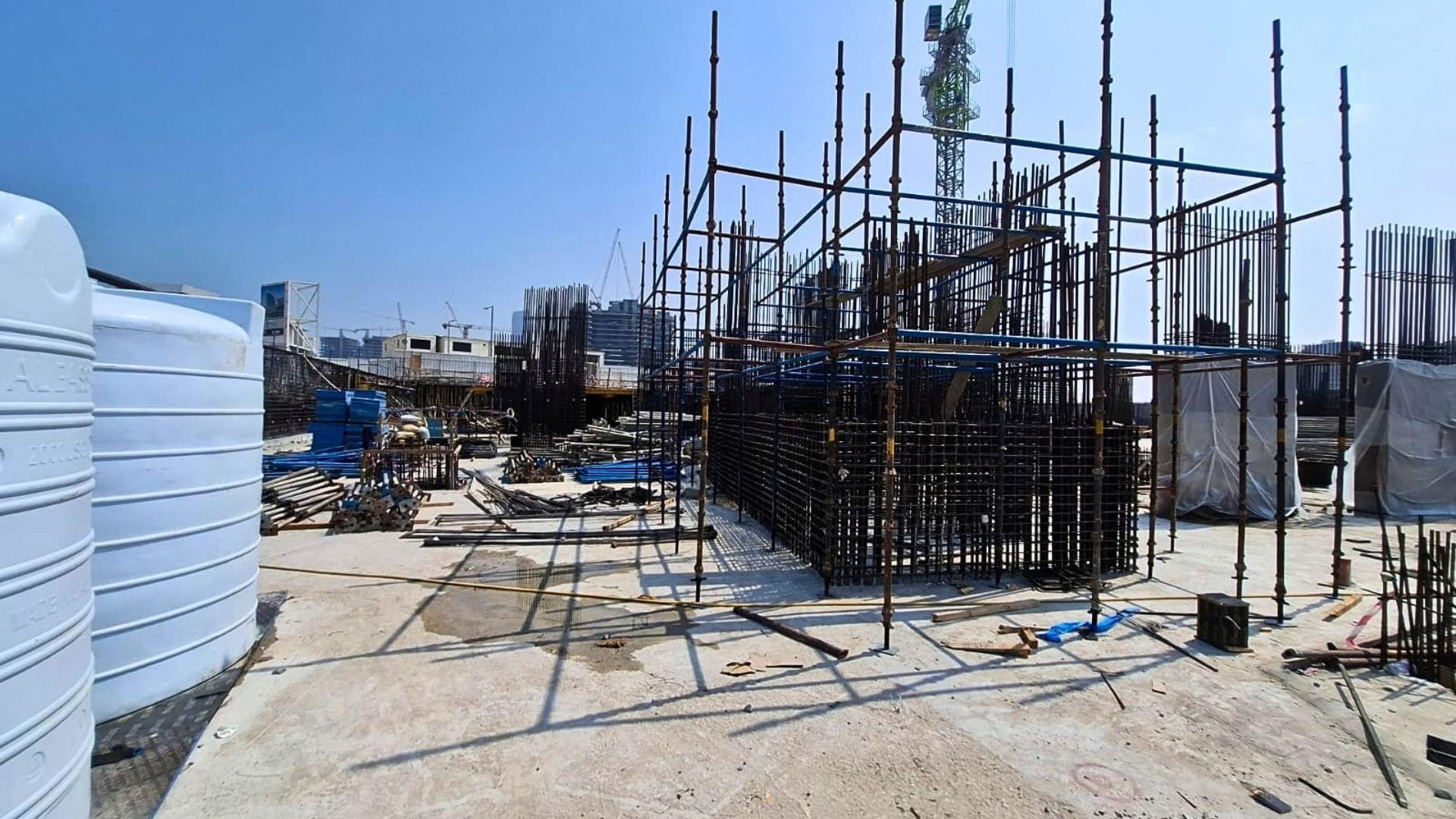

Project Site Mobilization
:
Completed
Soil Investigation
:
Done
Soil Improvement
:
Completed
Completion of Enabling works
:
Original Scope is Completed / Additional Shoring Works in Progress , 45% Done.
Dewatering System
:
Installation Completed

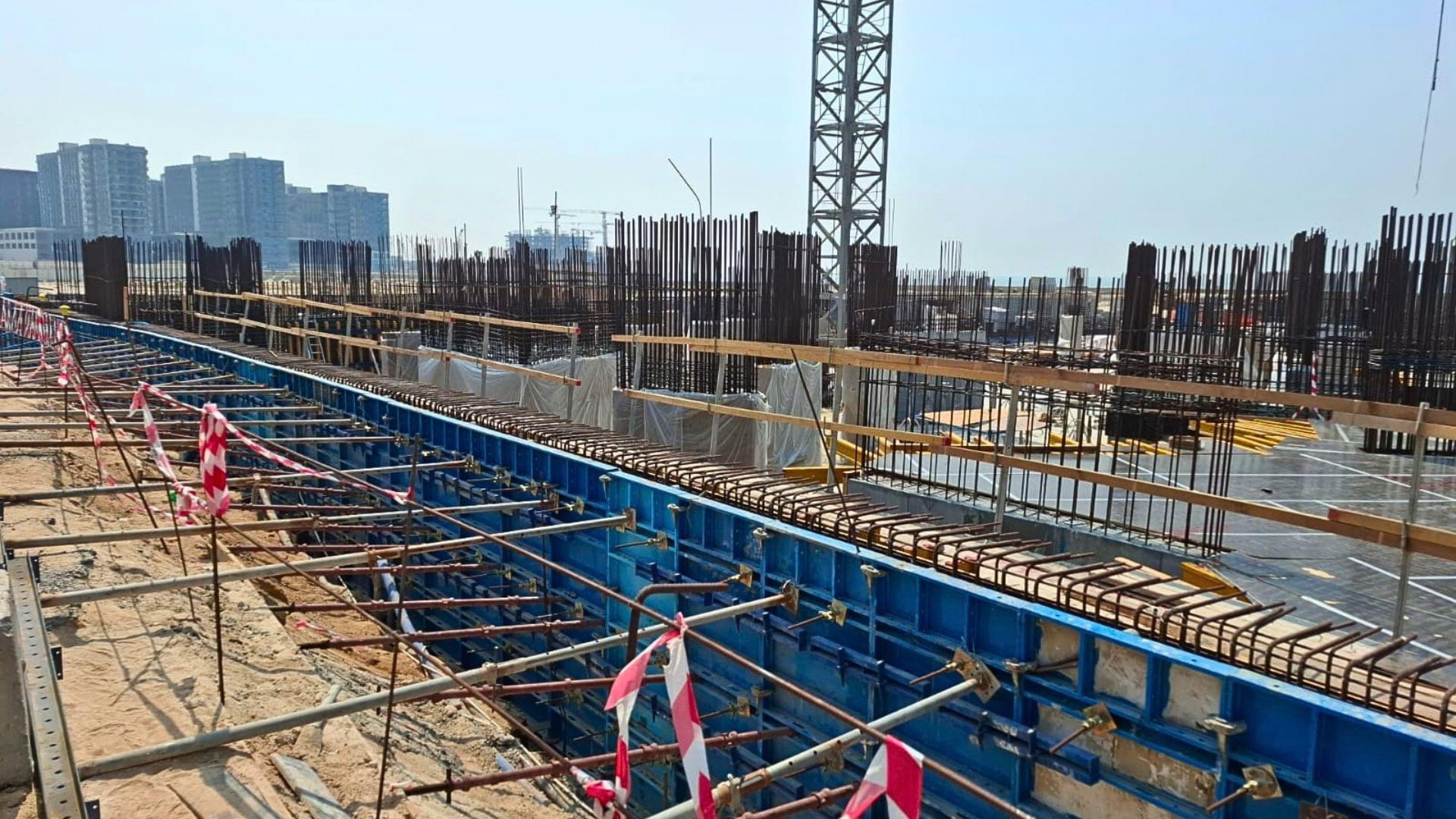

Excavation
:
Completed 1st Stage up to Pile Platform level, Stage 2 on progress.

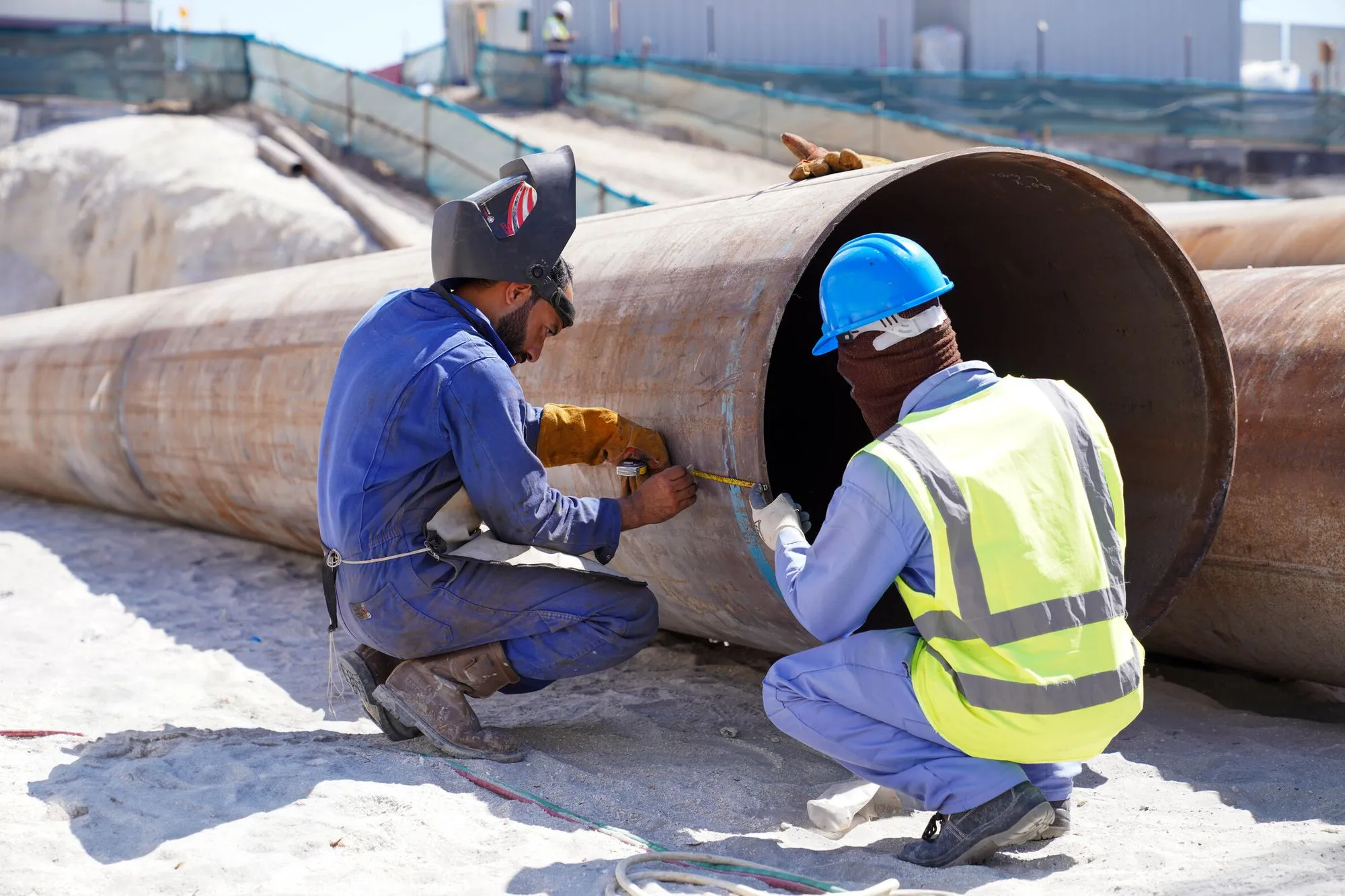

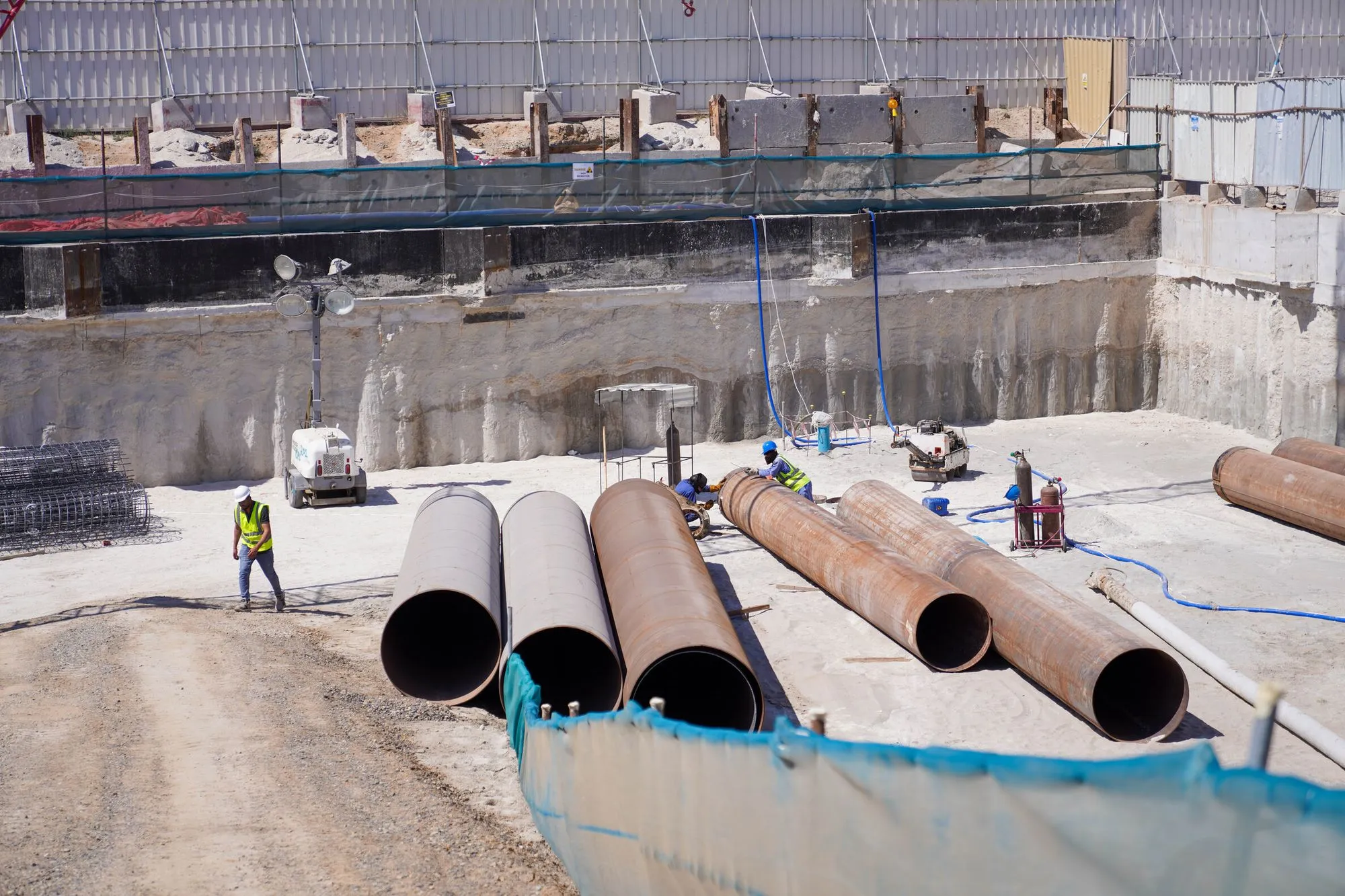

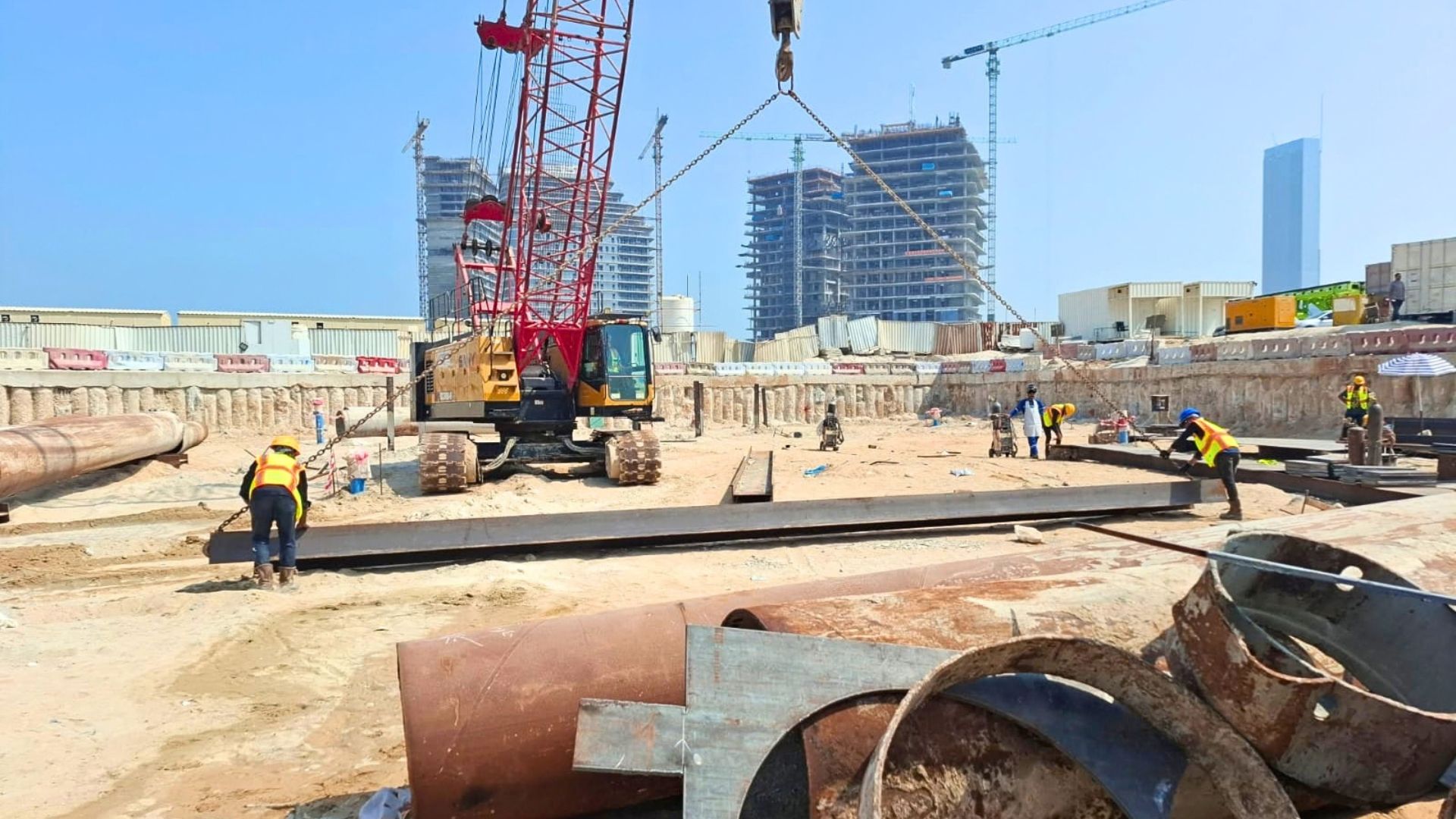

Piling works
:
Piling Permit issued from Rak Municipality , Piling Works on progress, 75% Done.
